RECONSTRUCTION IN 2020

RENOVATION OF THE WINDMILL FROM THE BEGINNING TO ITS OPENING TO THE PUBLIC

Later in 2018, soon after the municipal elections in Třebíč, the new council decided to renovate the windmill and to open it to the public. The plan to reconstruct the unique technical monument was one of the priority investments projects.

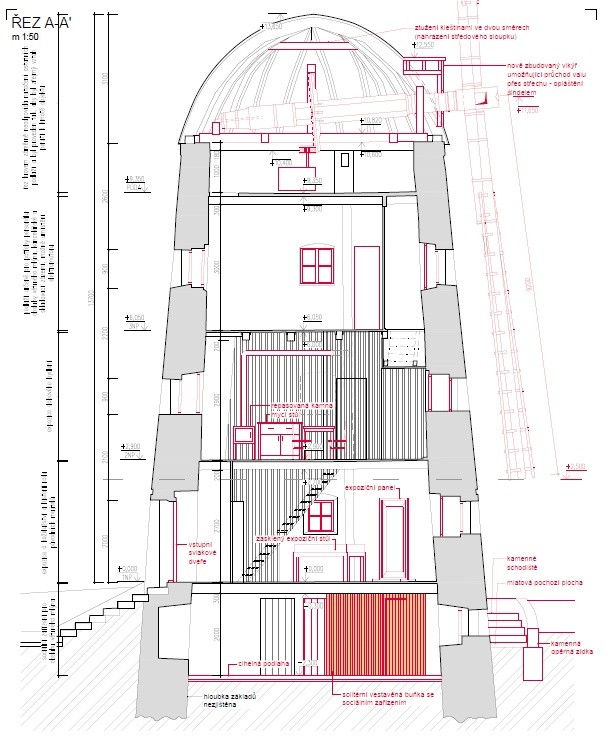

The project documentation was assigned to Archatt Památky Company, namely to Mr. Ing. Arch. Petr Řehořek. Since the preparation of the project documentation started, the project has been consulted with the responsible experts from the Czech National Heritage Board in Telč.

As renovation of the entire original milling device was not possible, the wind wheel was anchored in its original place and was equipped with an electric power drive.

The tender for realization of the Třebíč-Borovina Windmill Renovation Contract was won by MALANG s.r.o. Brno Company.

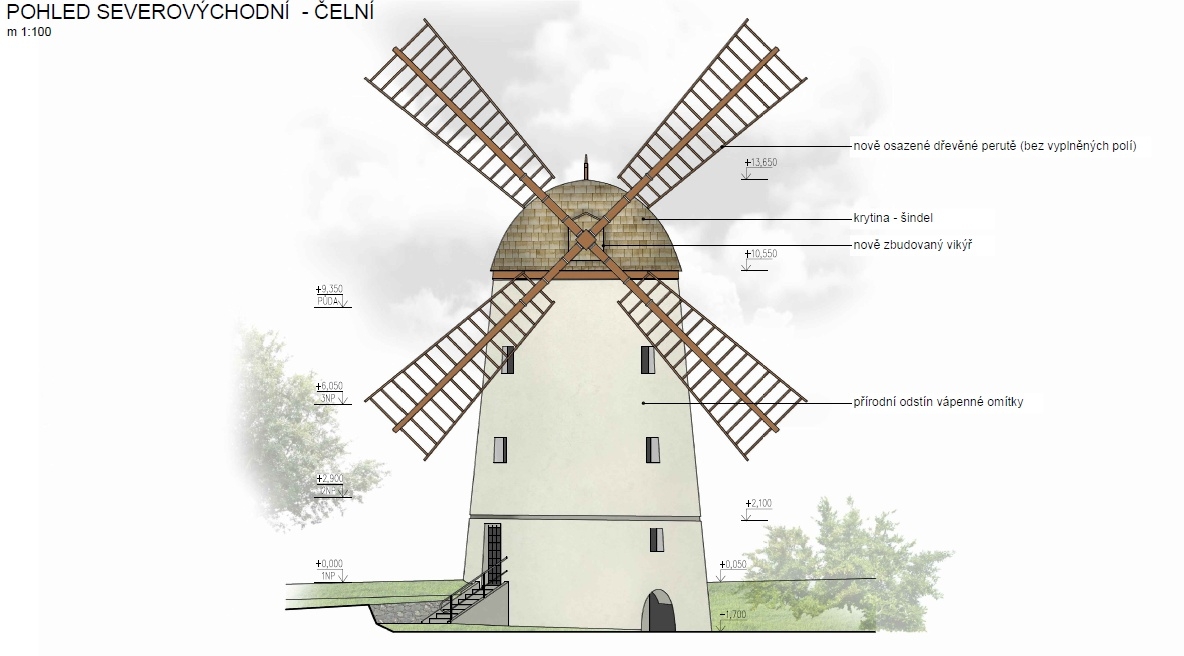

June 2019 - visualization of the project

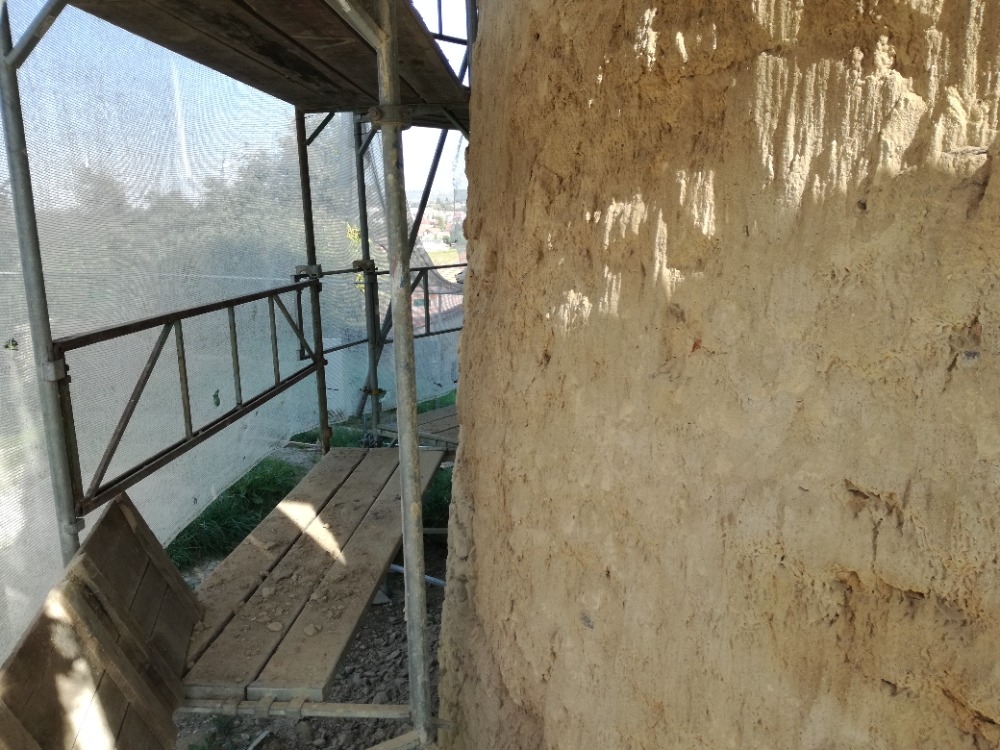

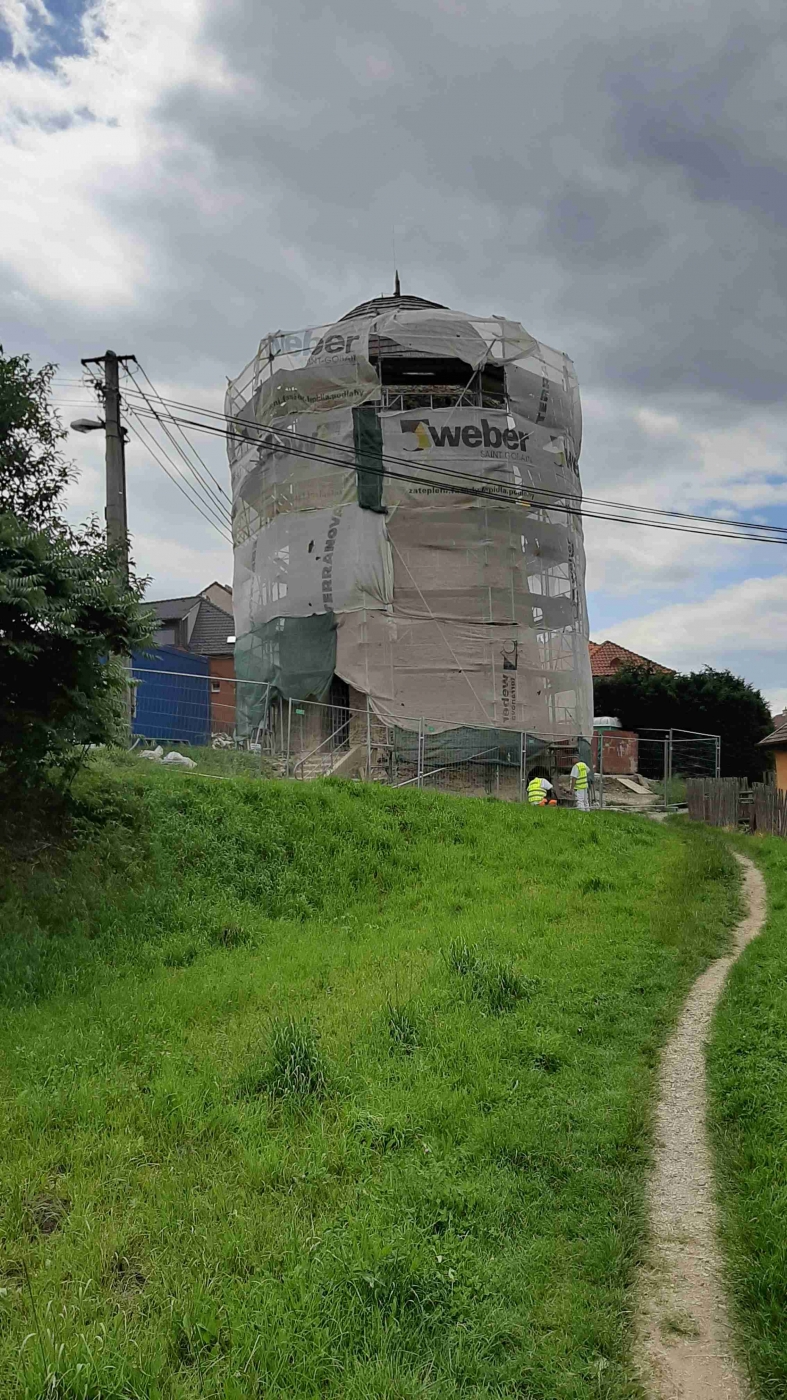

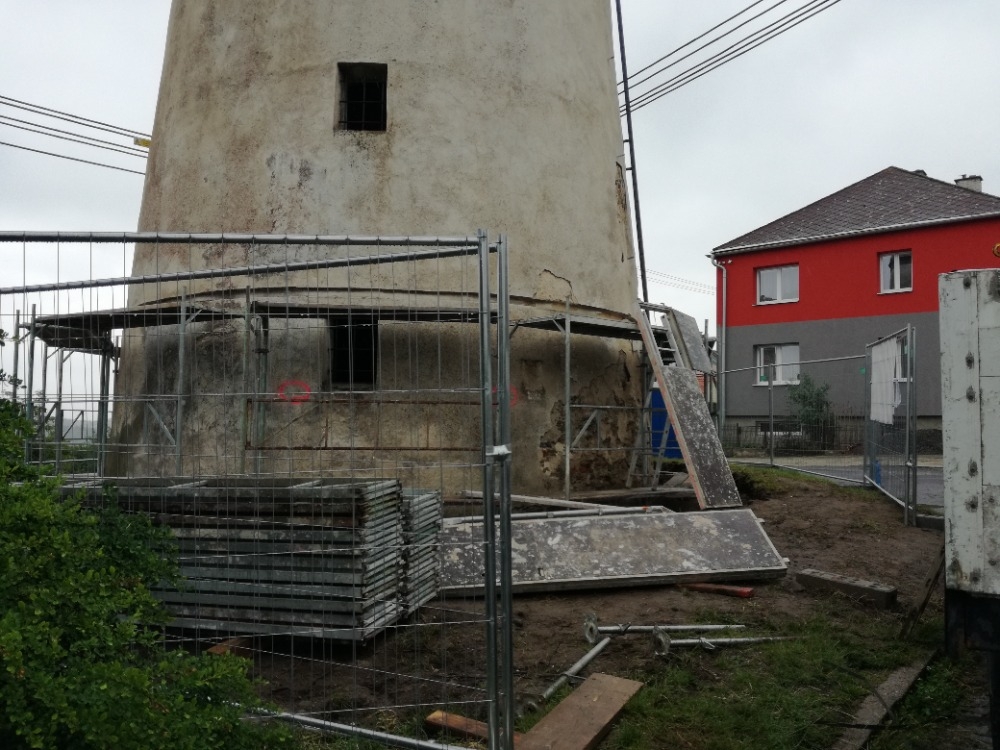

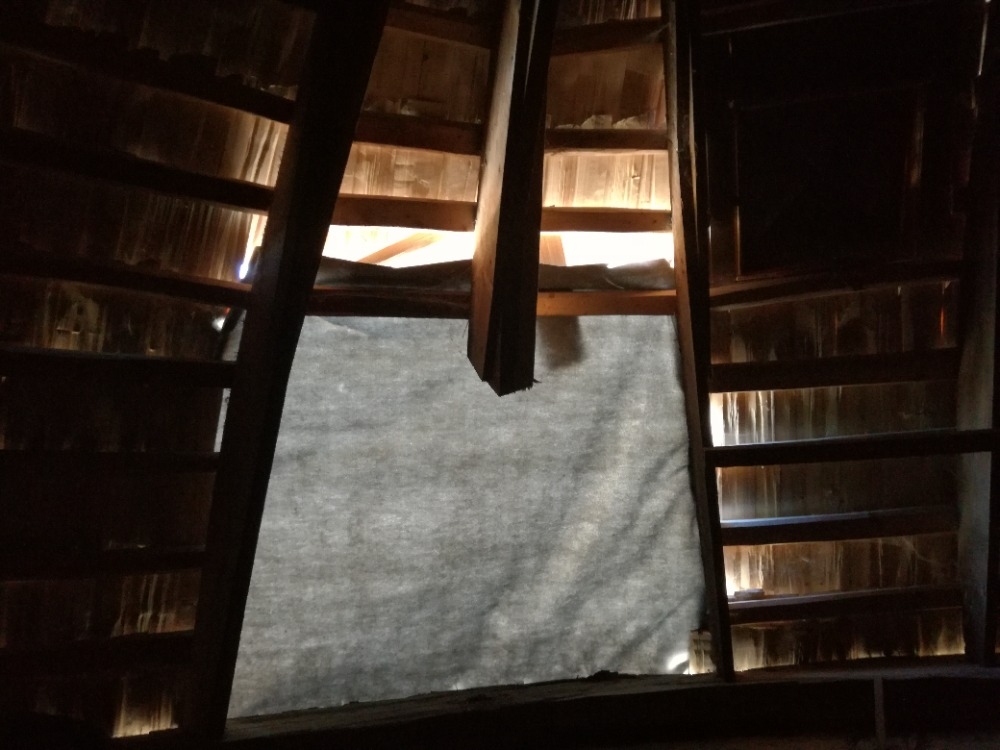

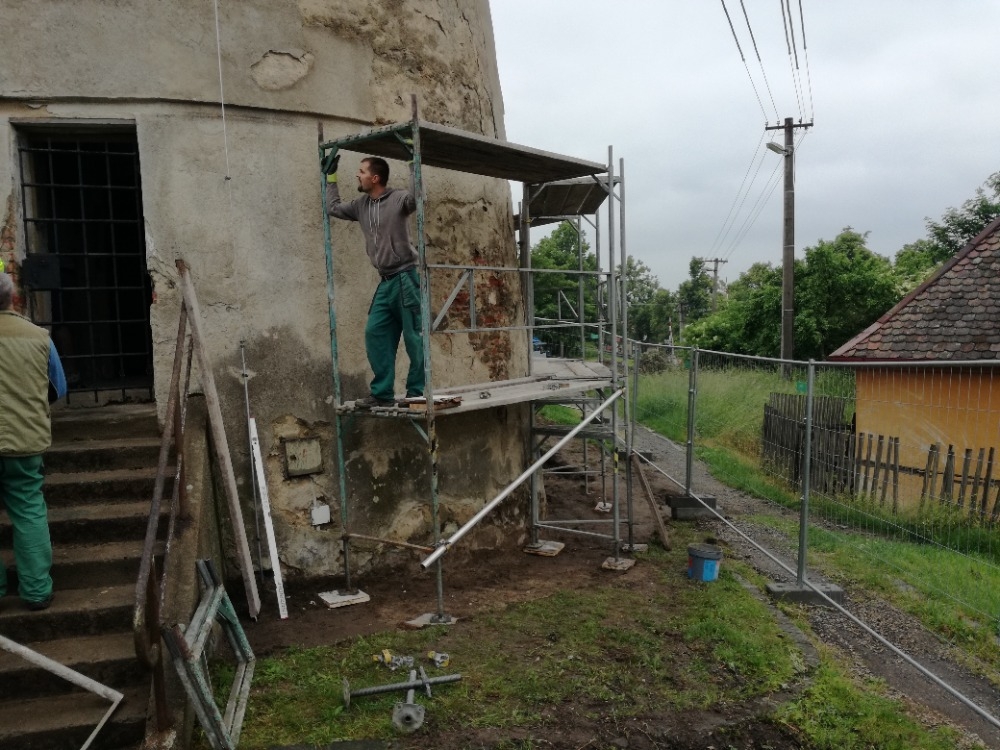

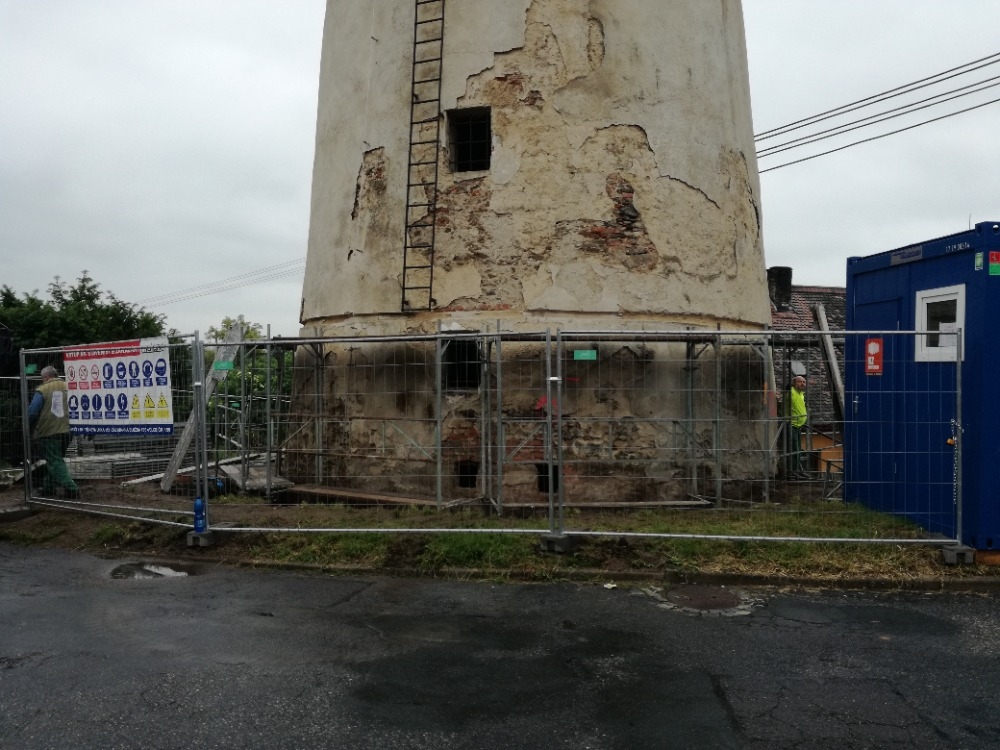

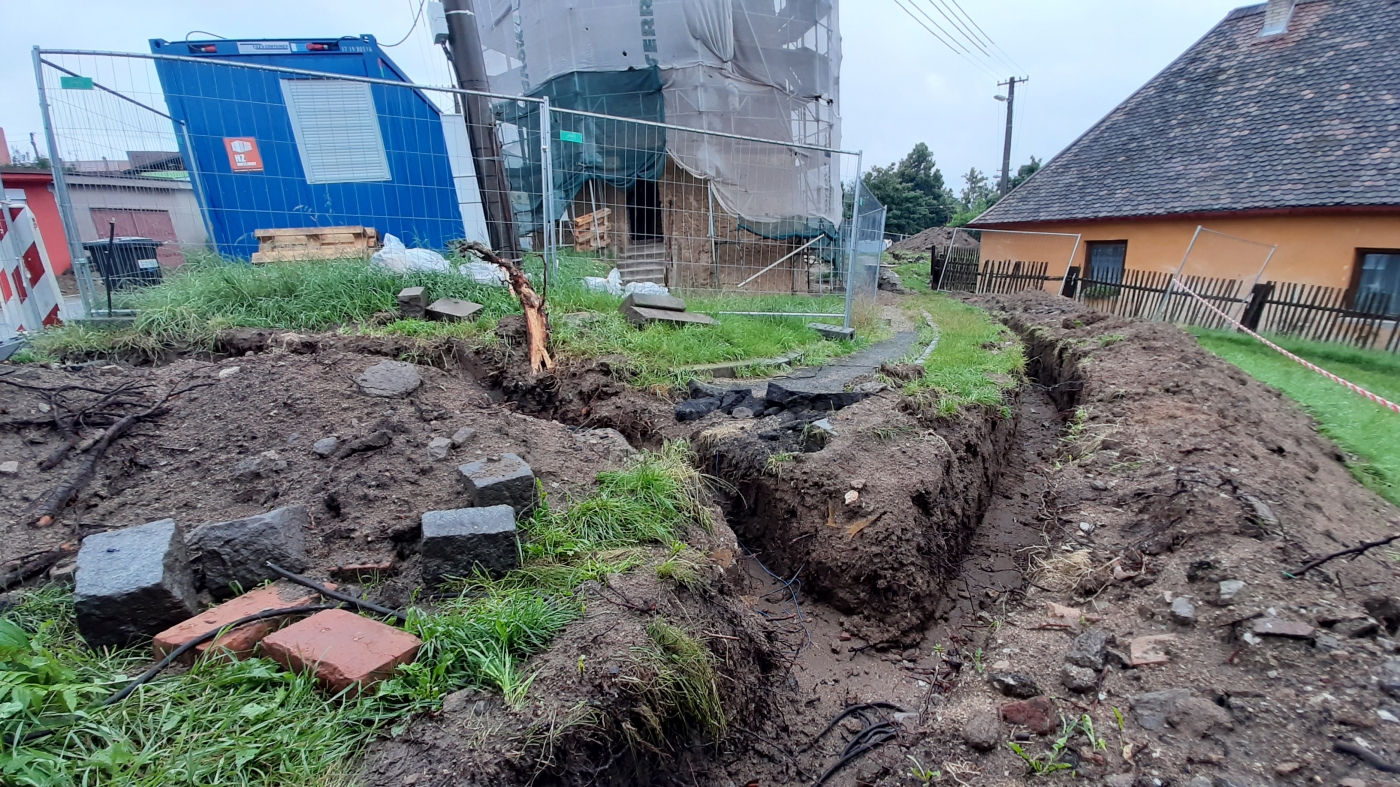

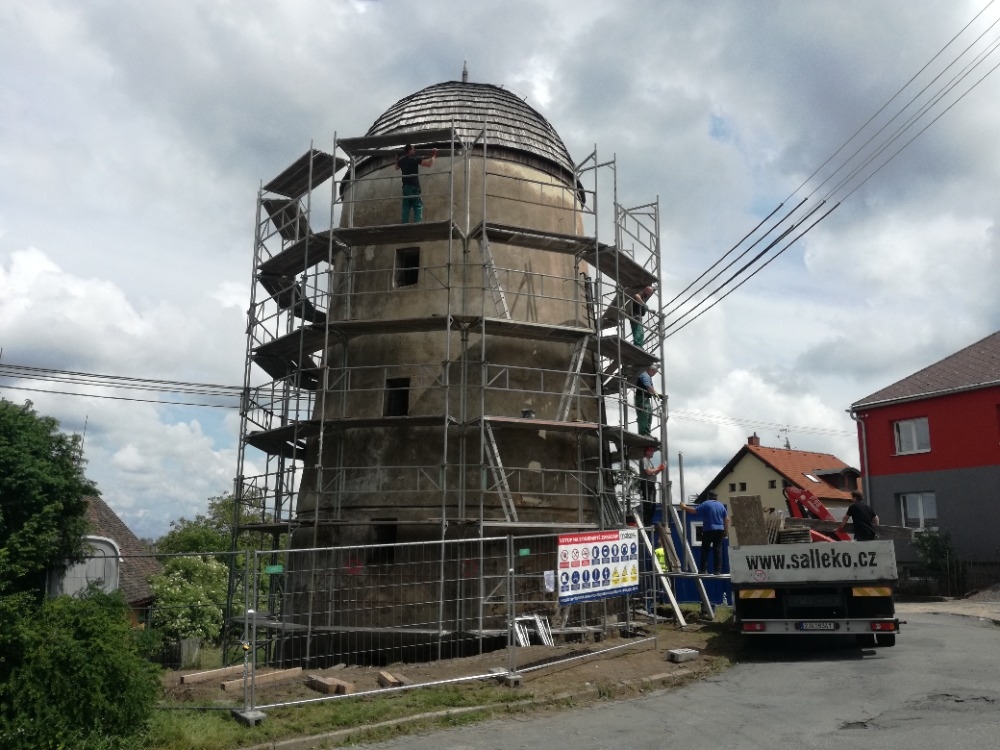

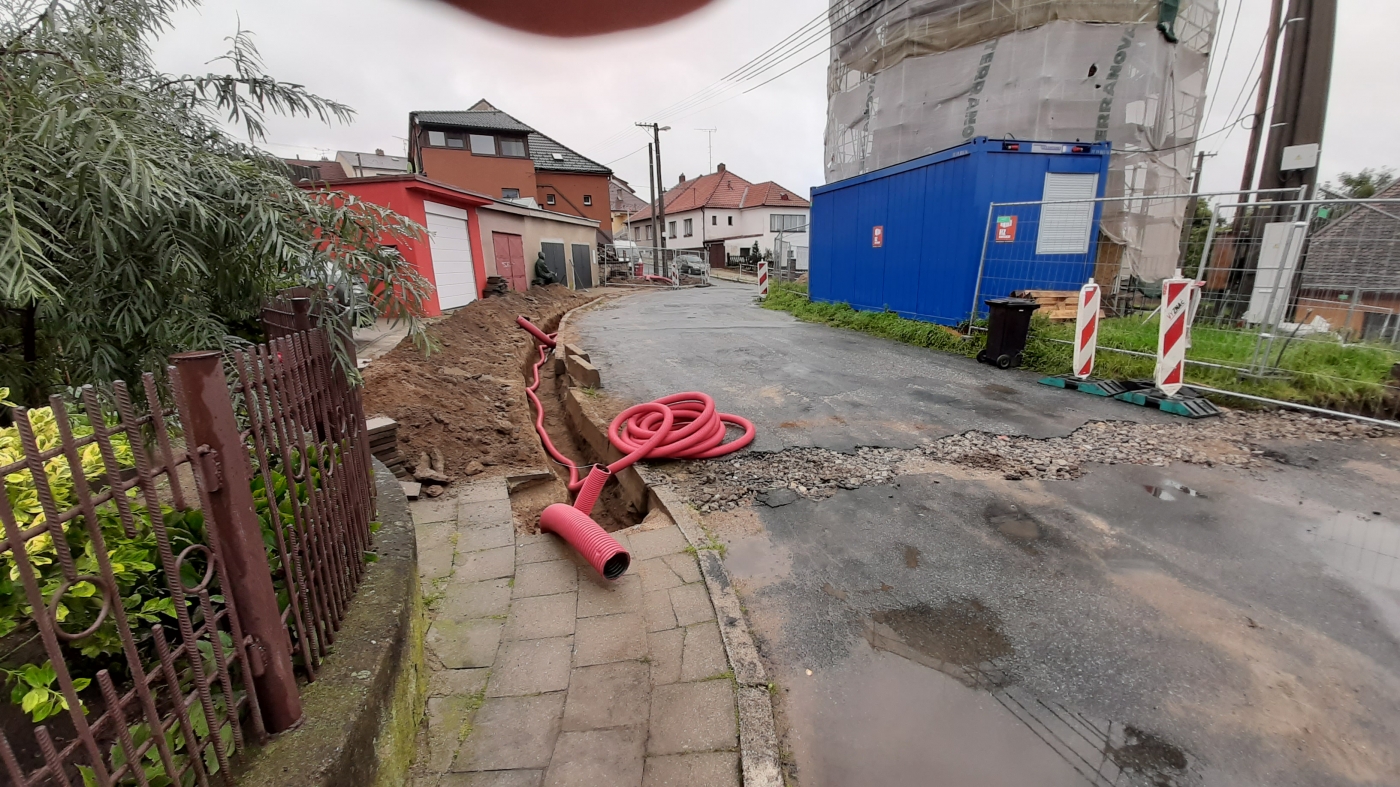

JUNE 2020 - START OF CONSTRUCTION, SCAFFOLDING CONSTRUCTION, CLEANING AND DISASSEMBLY OF ORIGINAL ELEMENTS

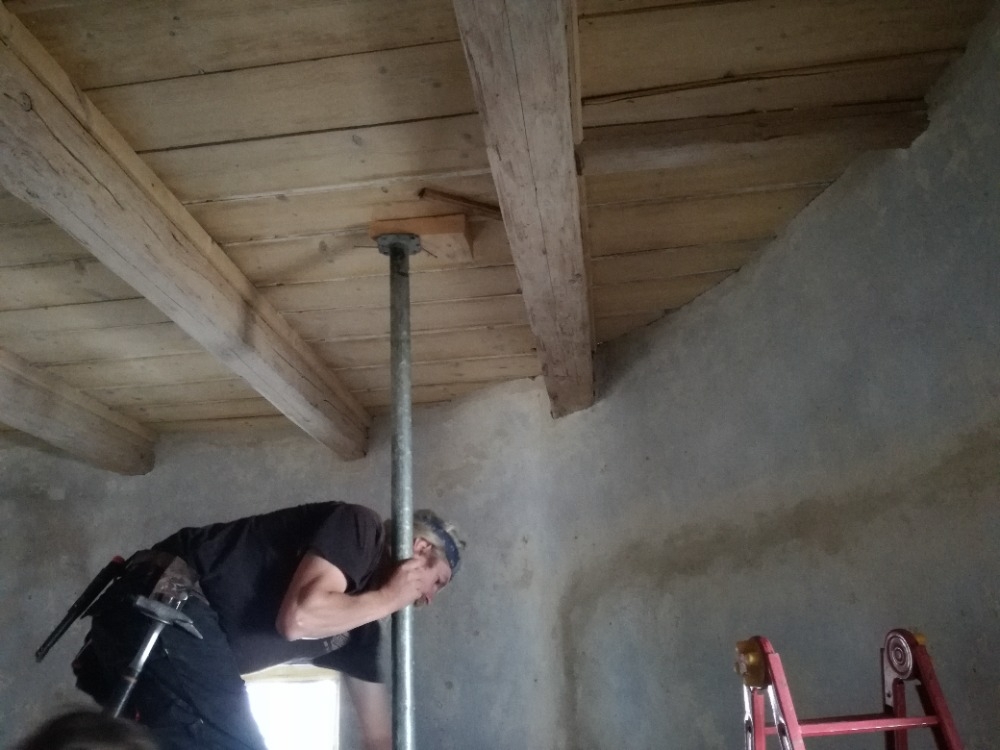

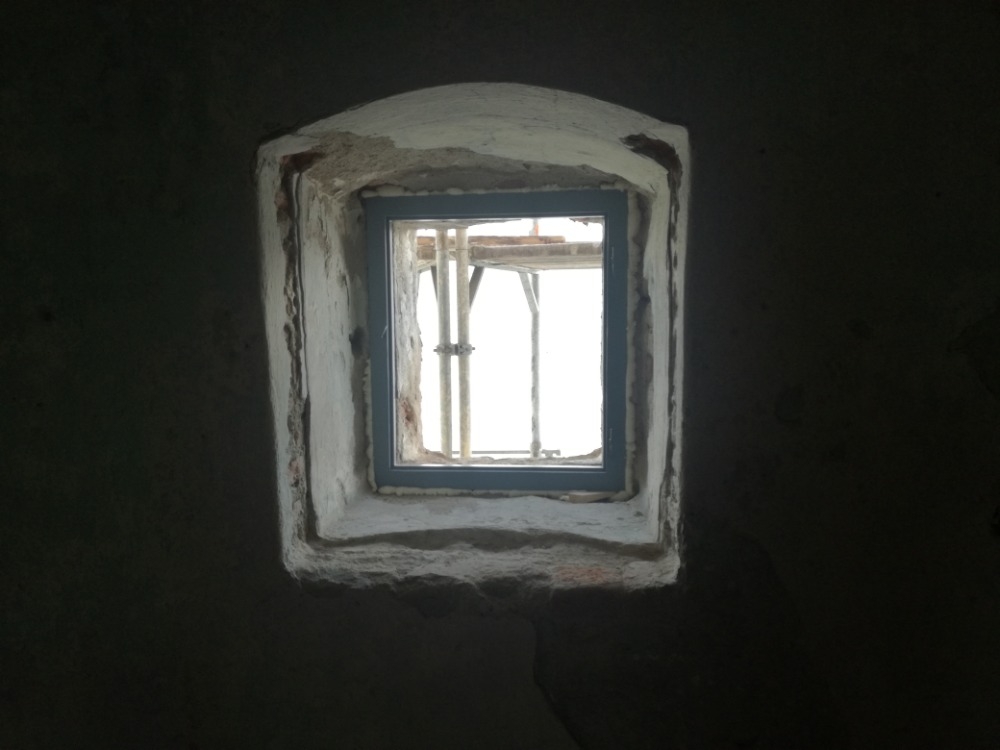

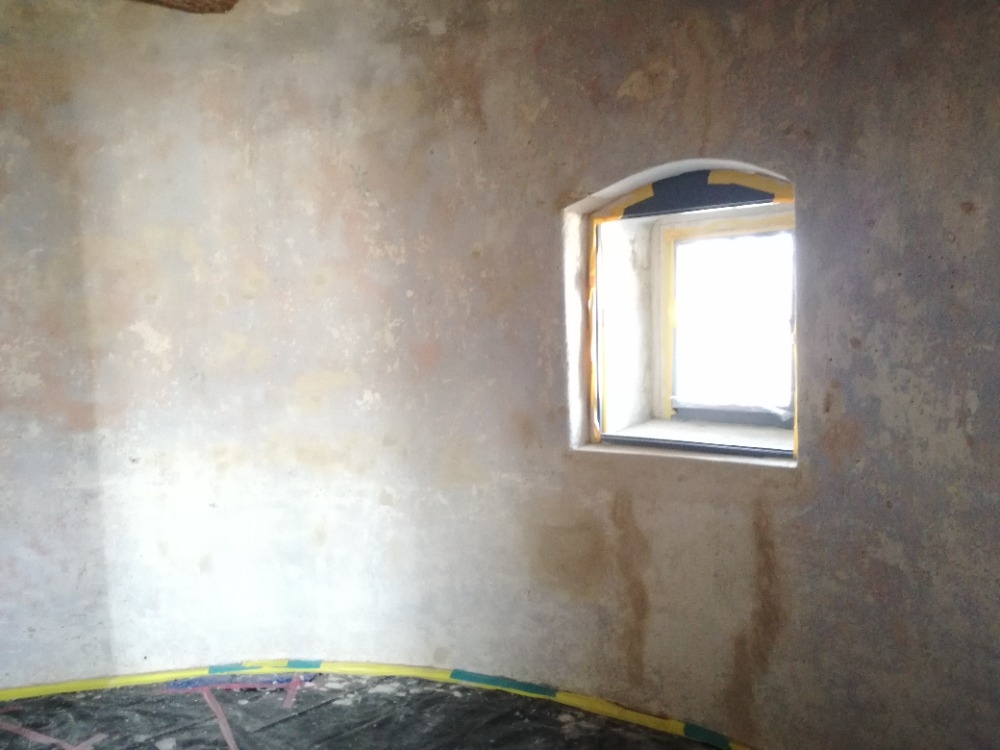

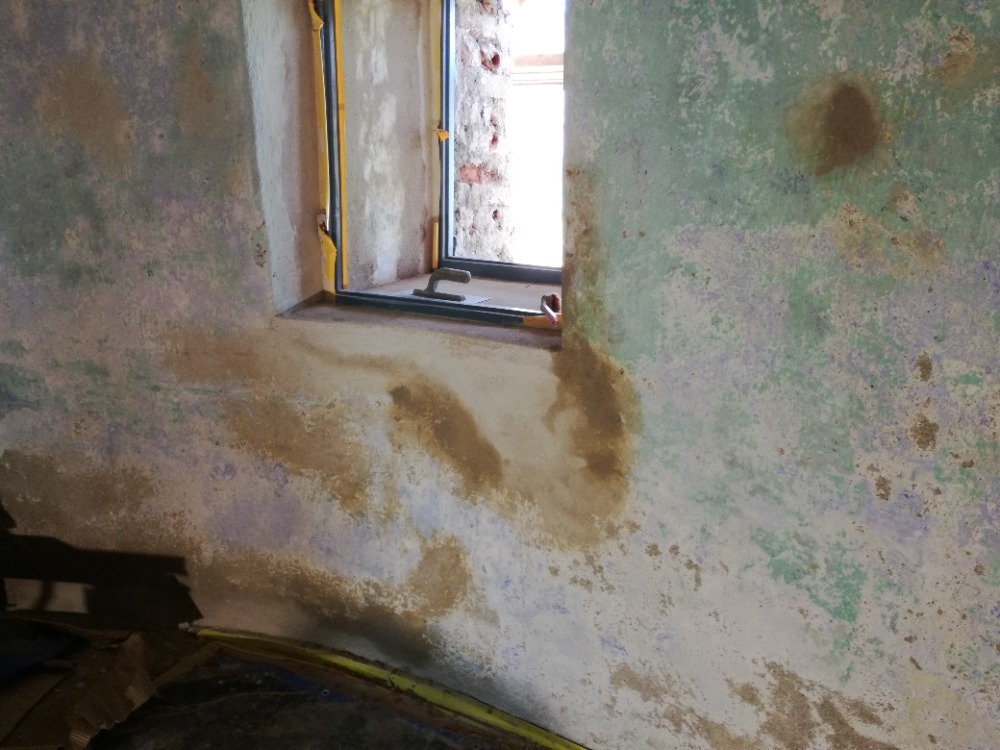

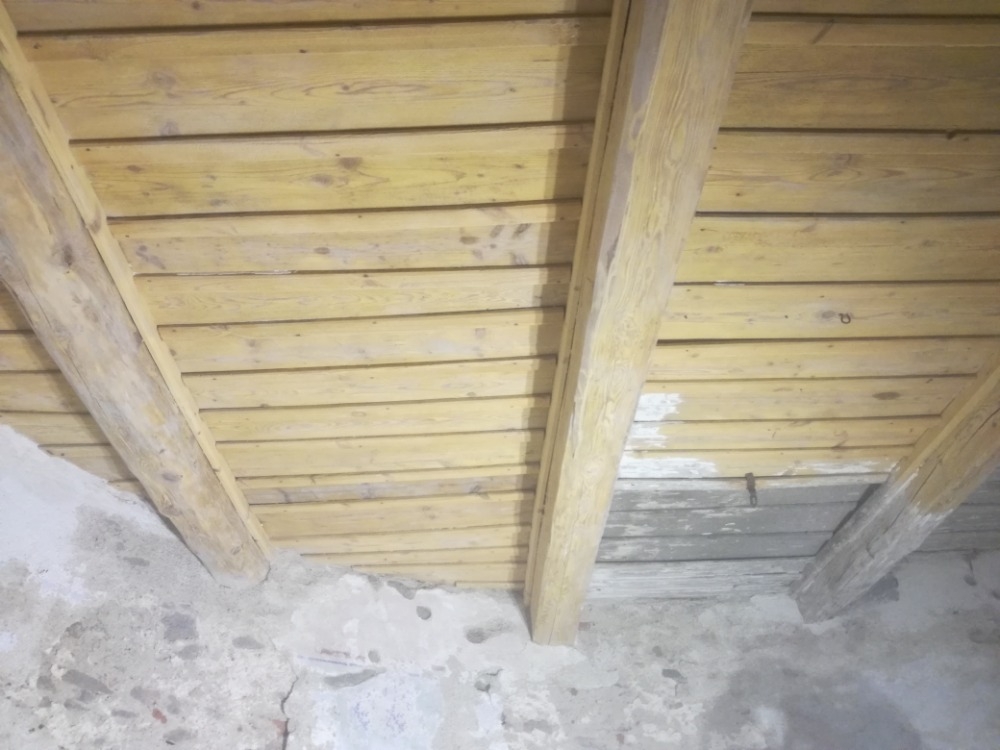

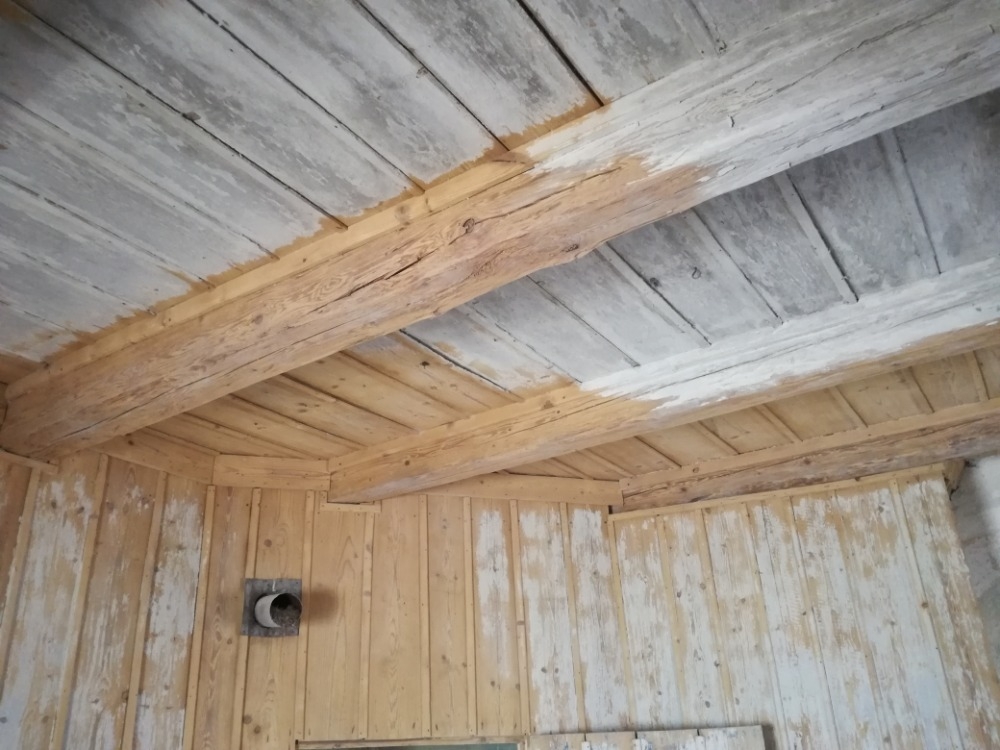

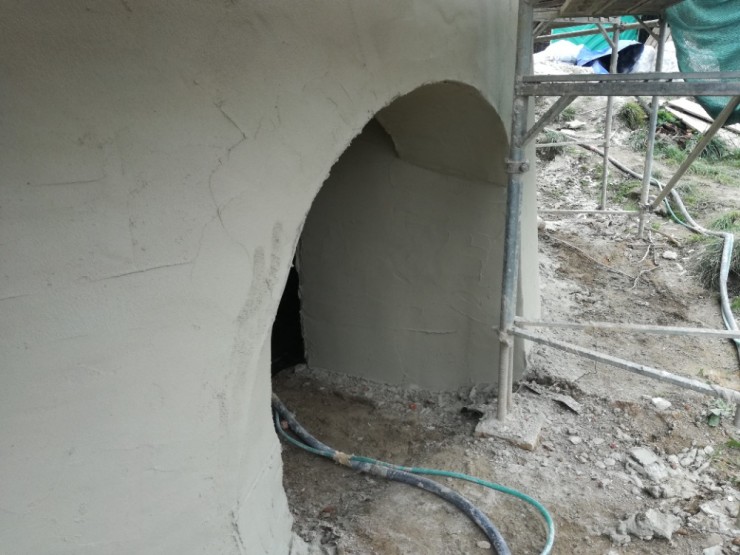

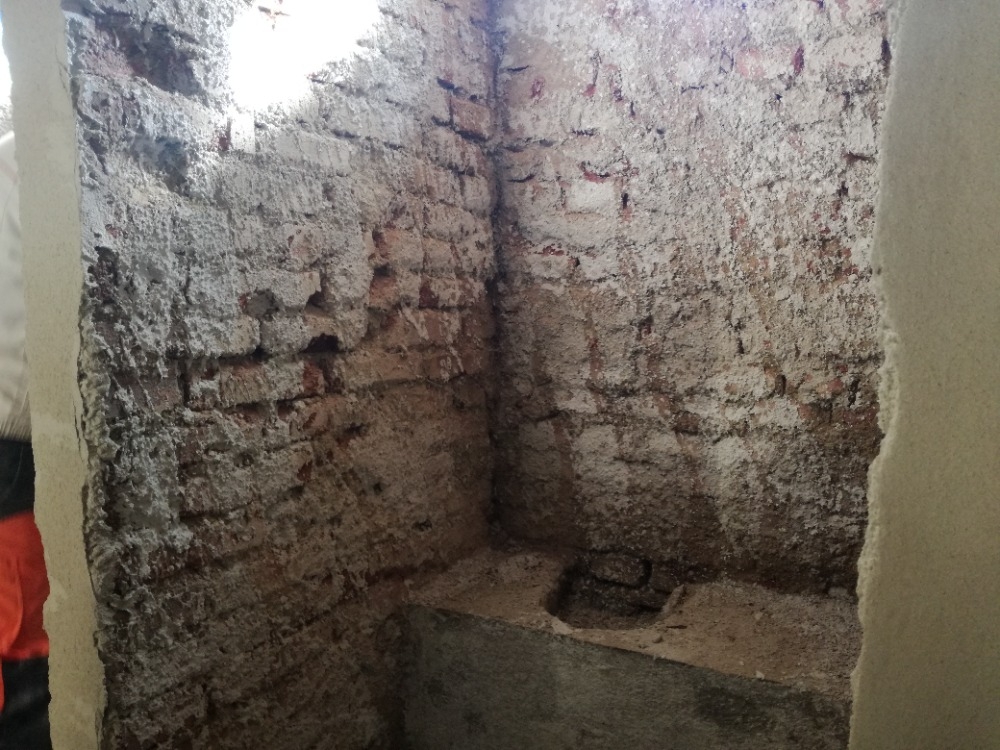

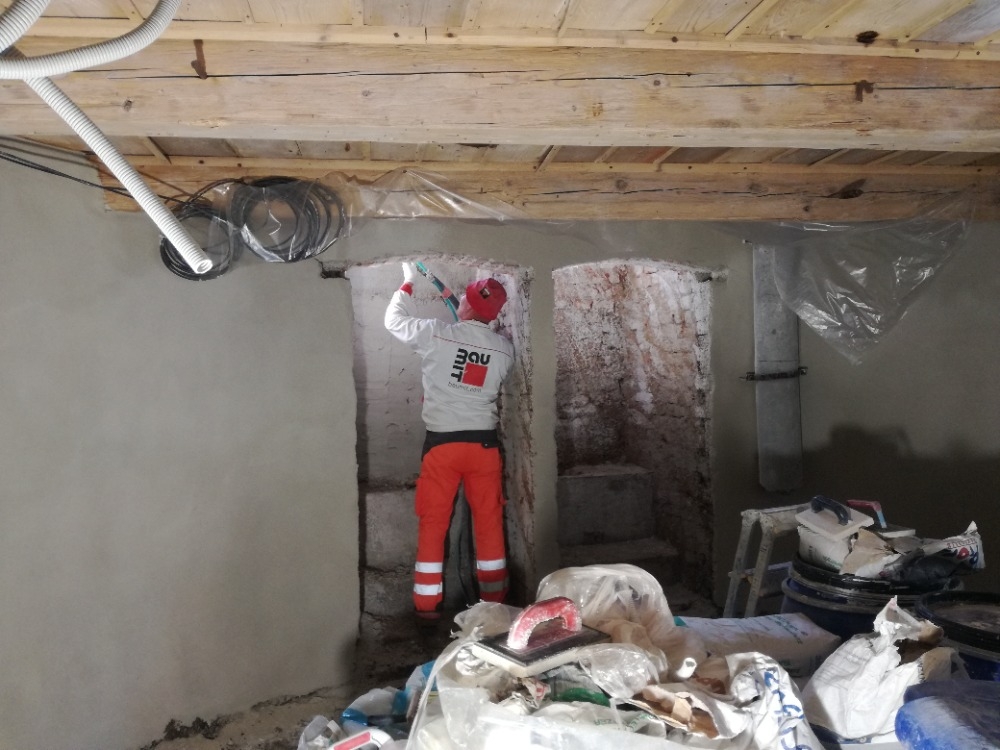

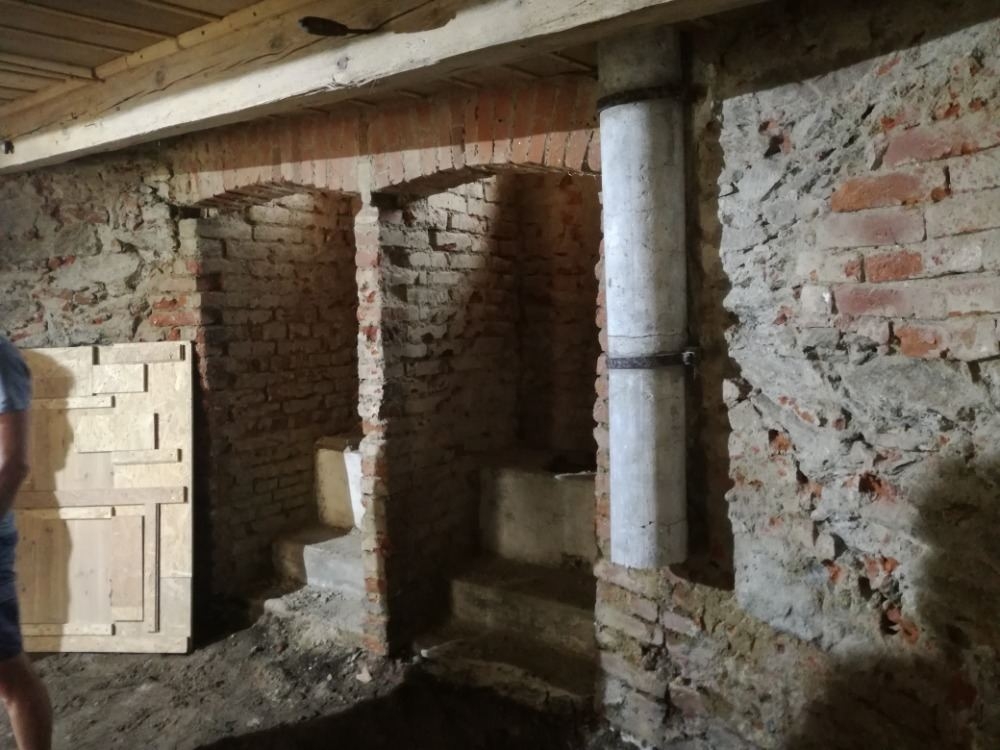

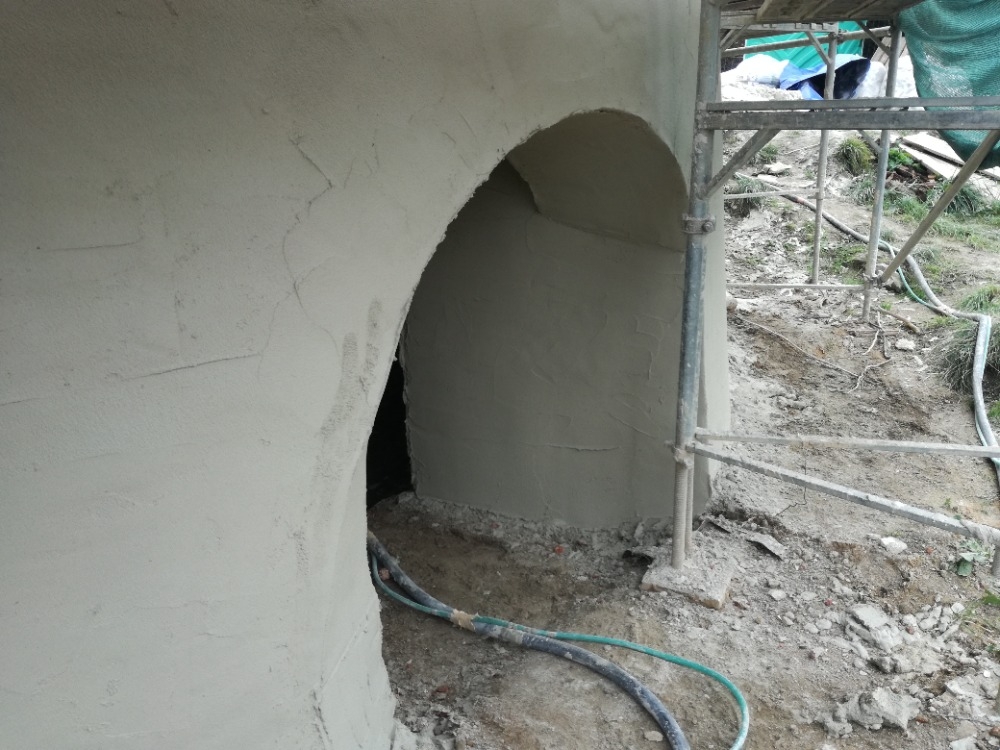

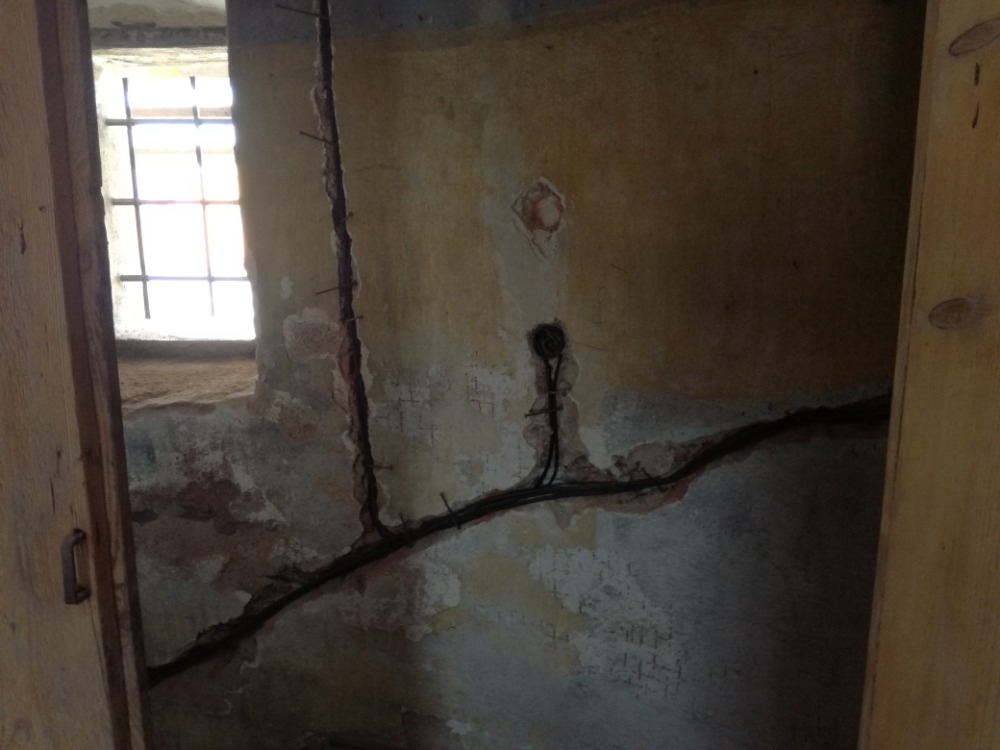

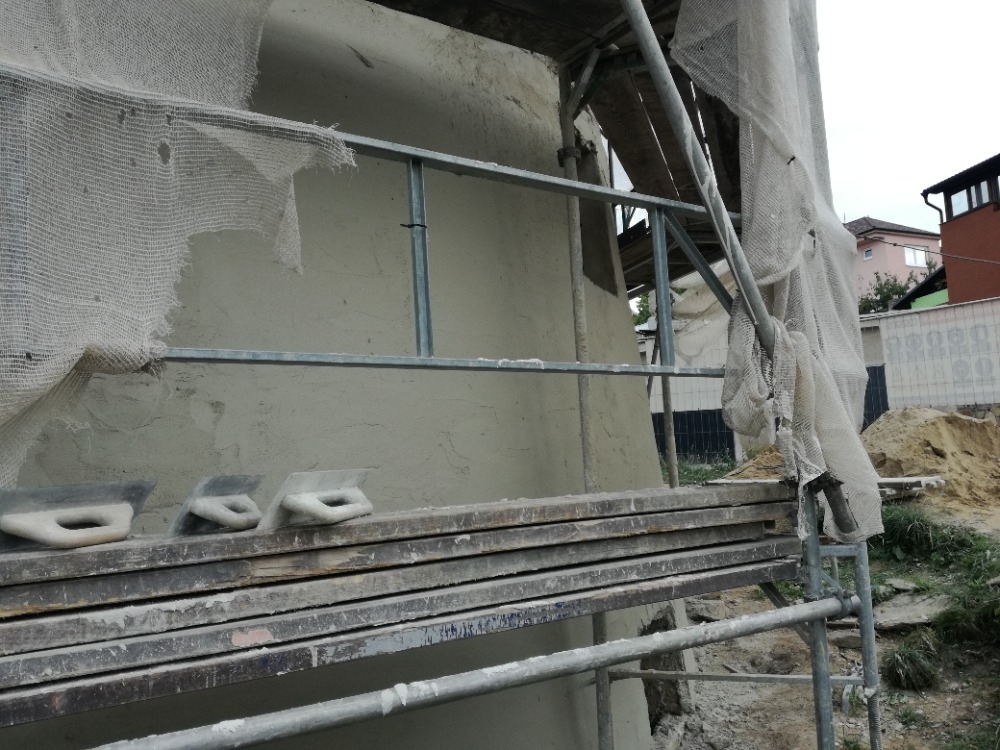

JULY 2020 - CLEANING AND REMOVAL OF DEGRADED PLASTER, PAINTING, FLOORS

AUGUST 2020 - DISTRIBUTION AND FLOORS

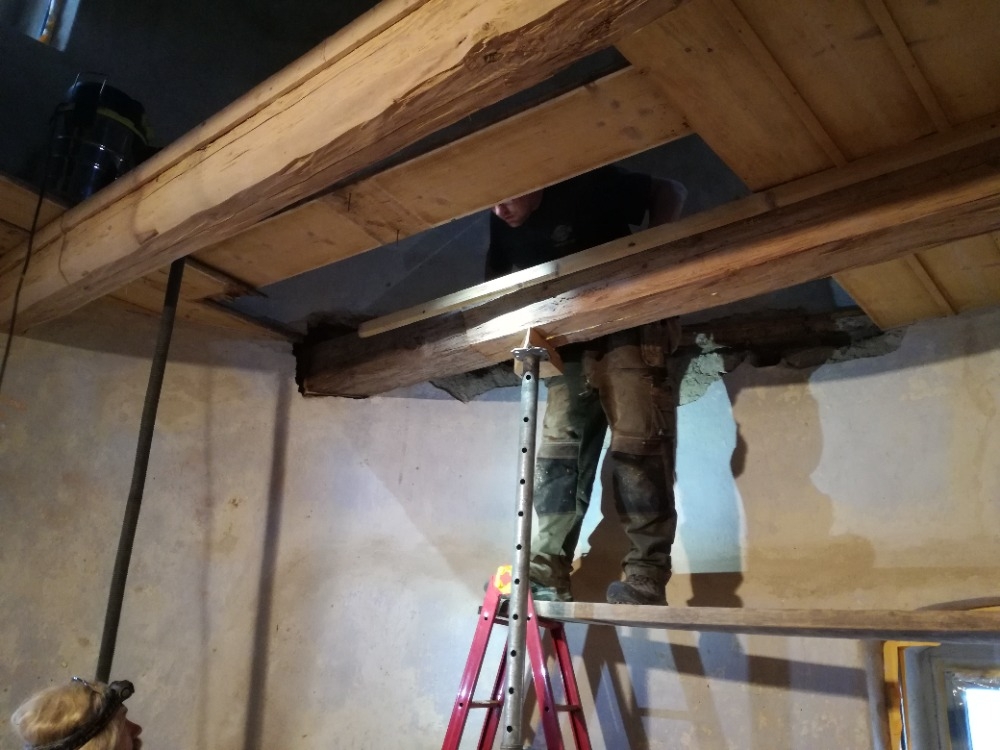

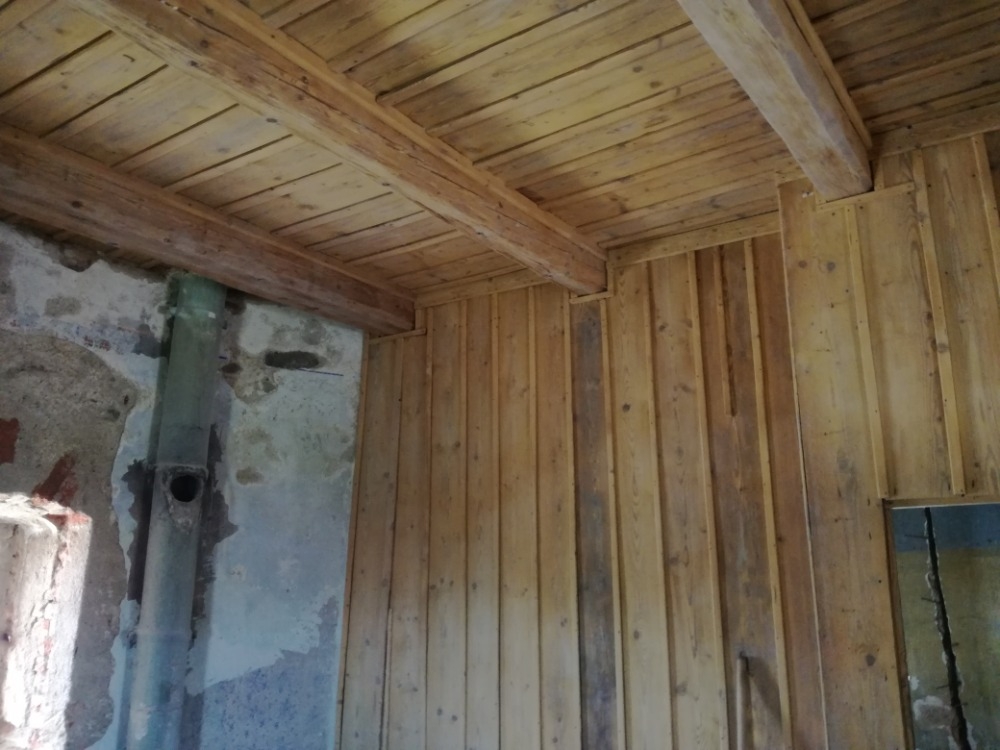

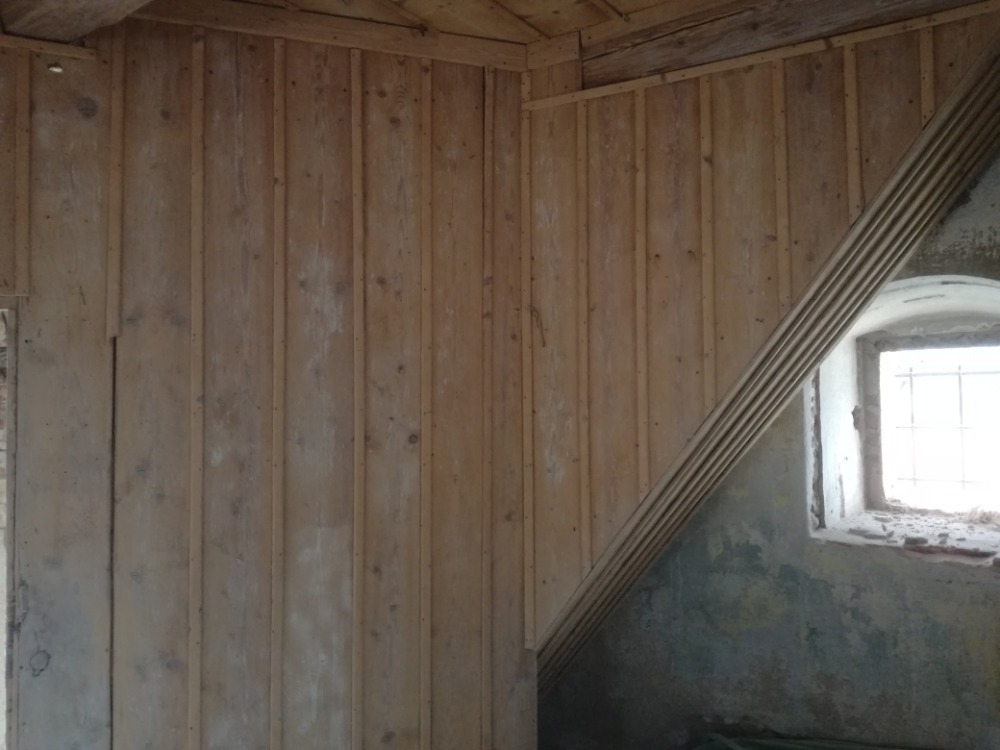

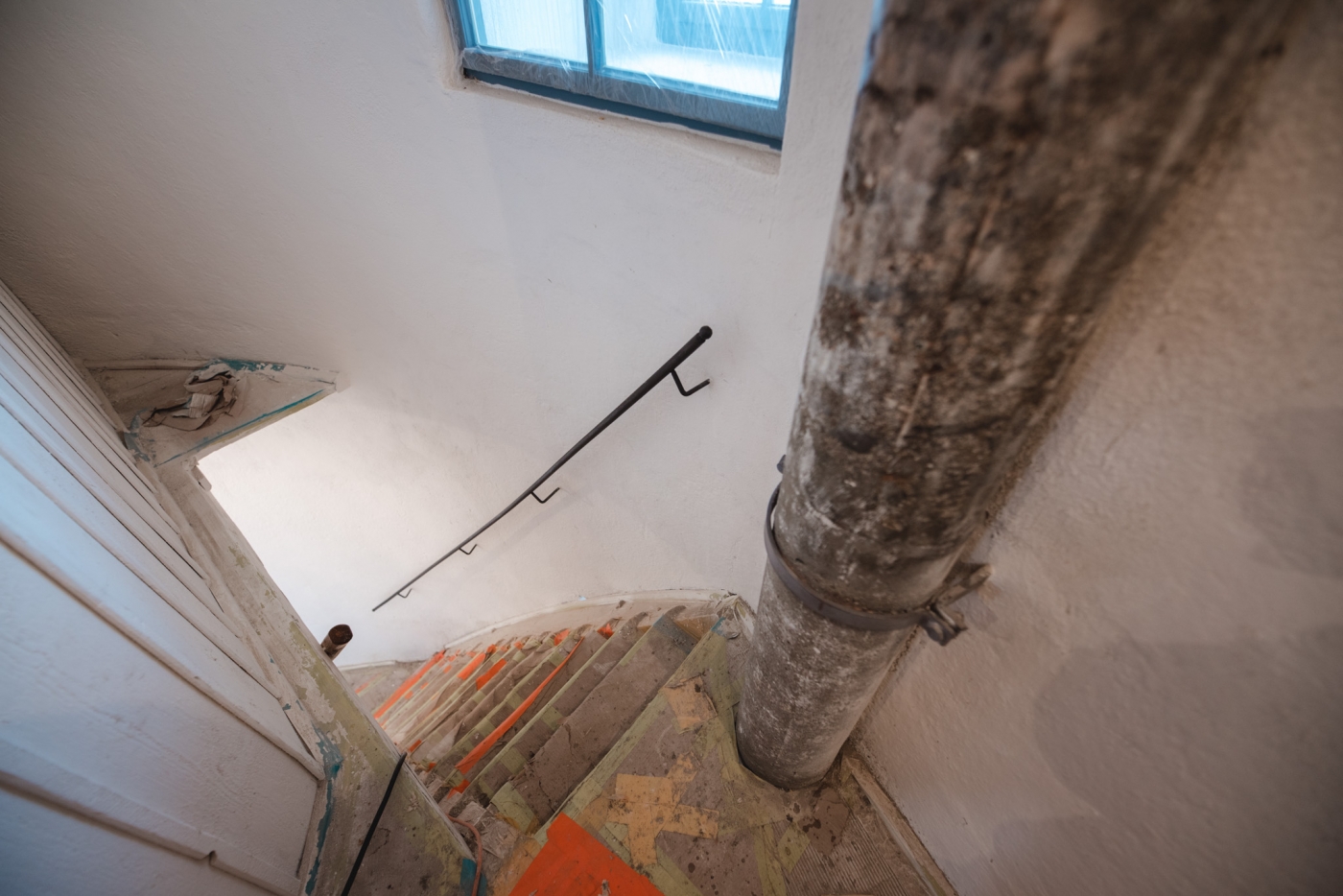

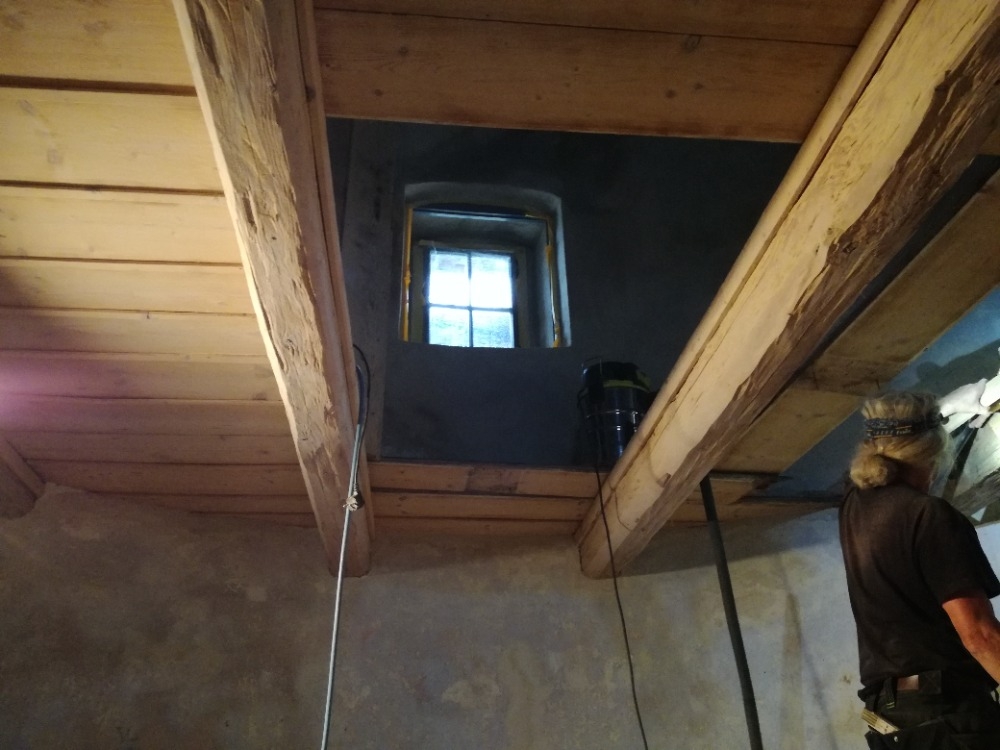

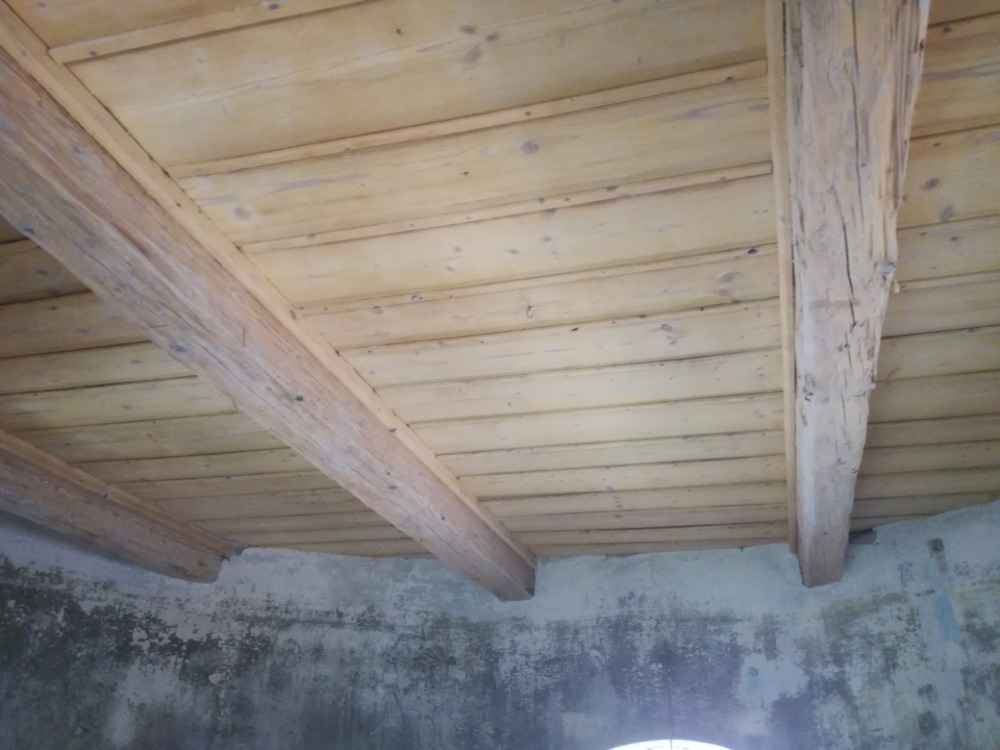

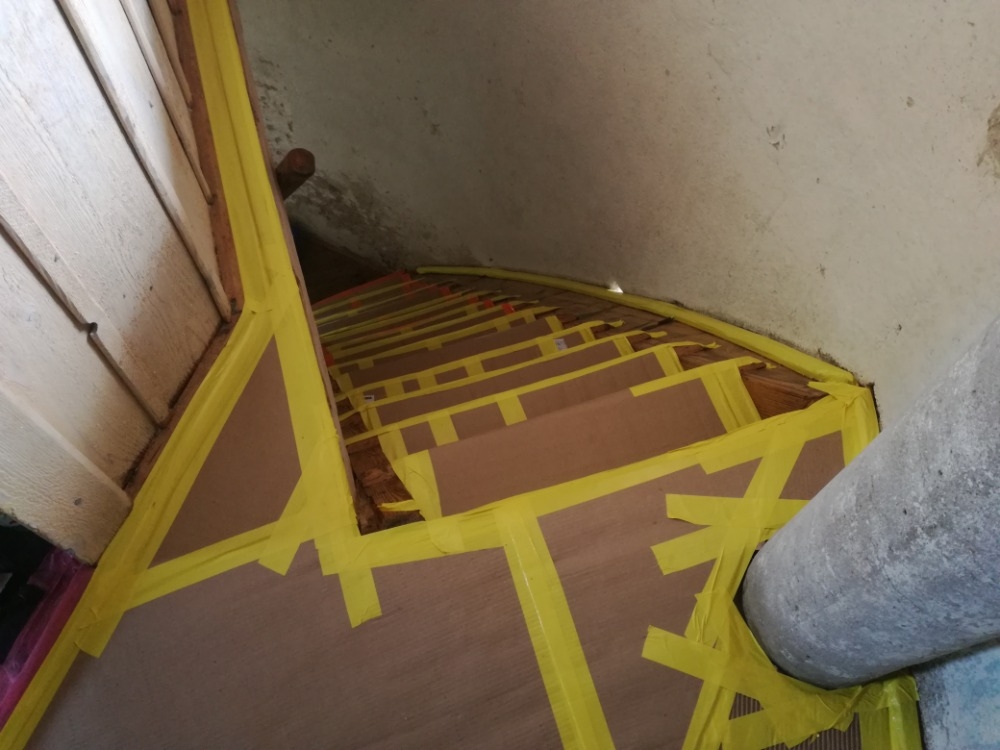

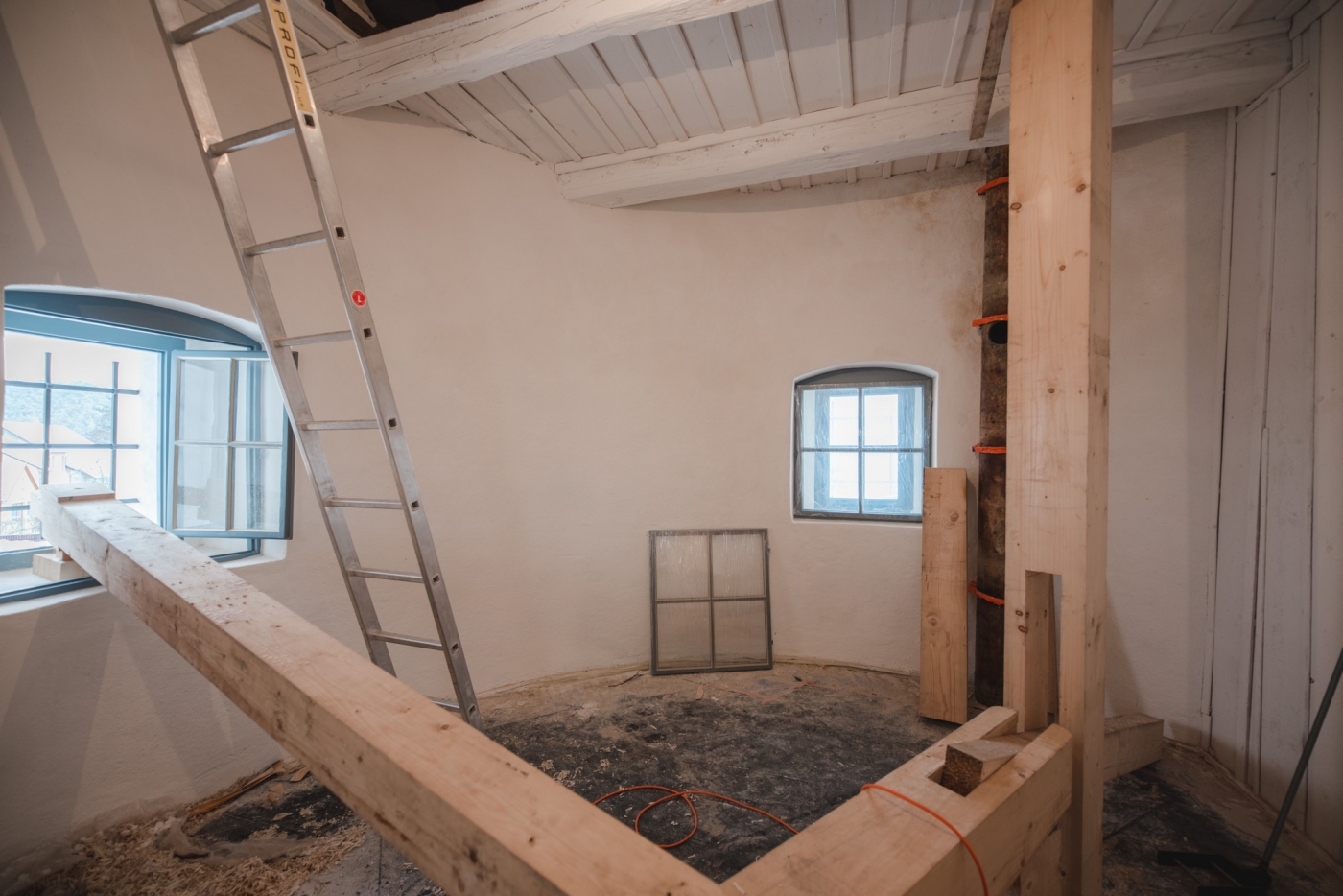

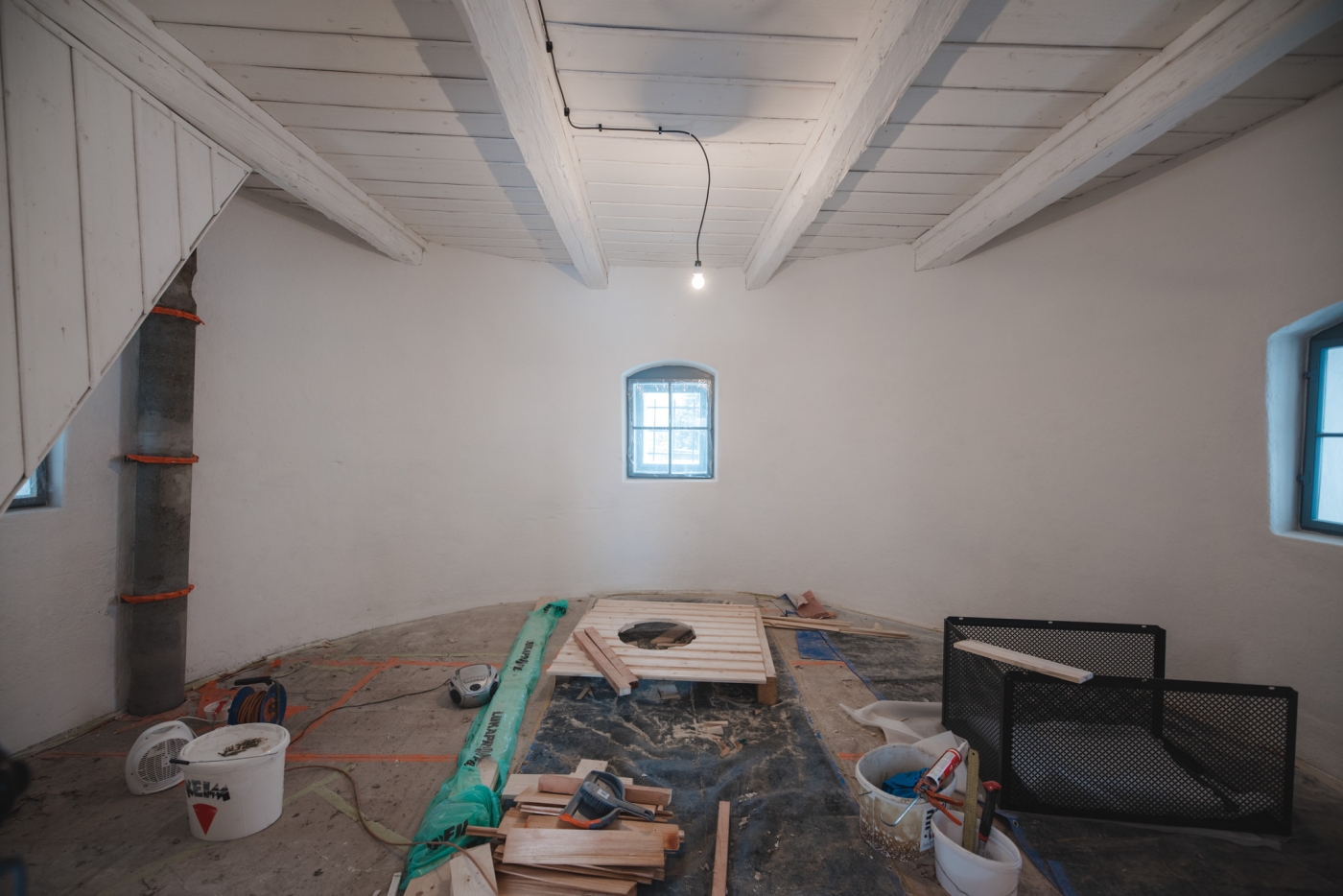

OCTOBER 2020 - REPAIR OF FLOORS AND BEAMS, JOINERY AND FORGING PRODUCTS

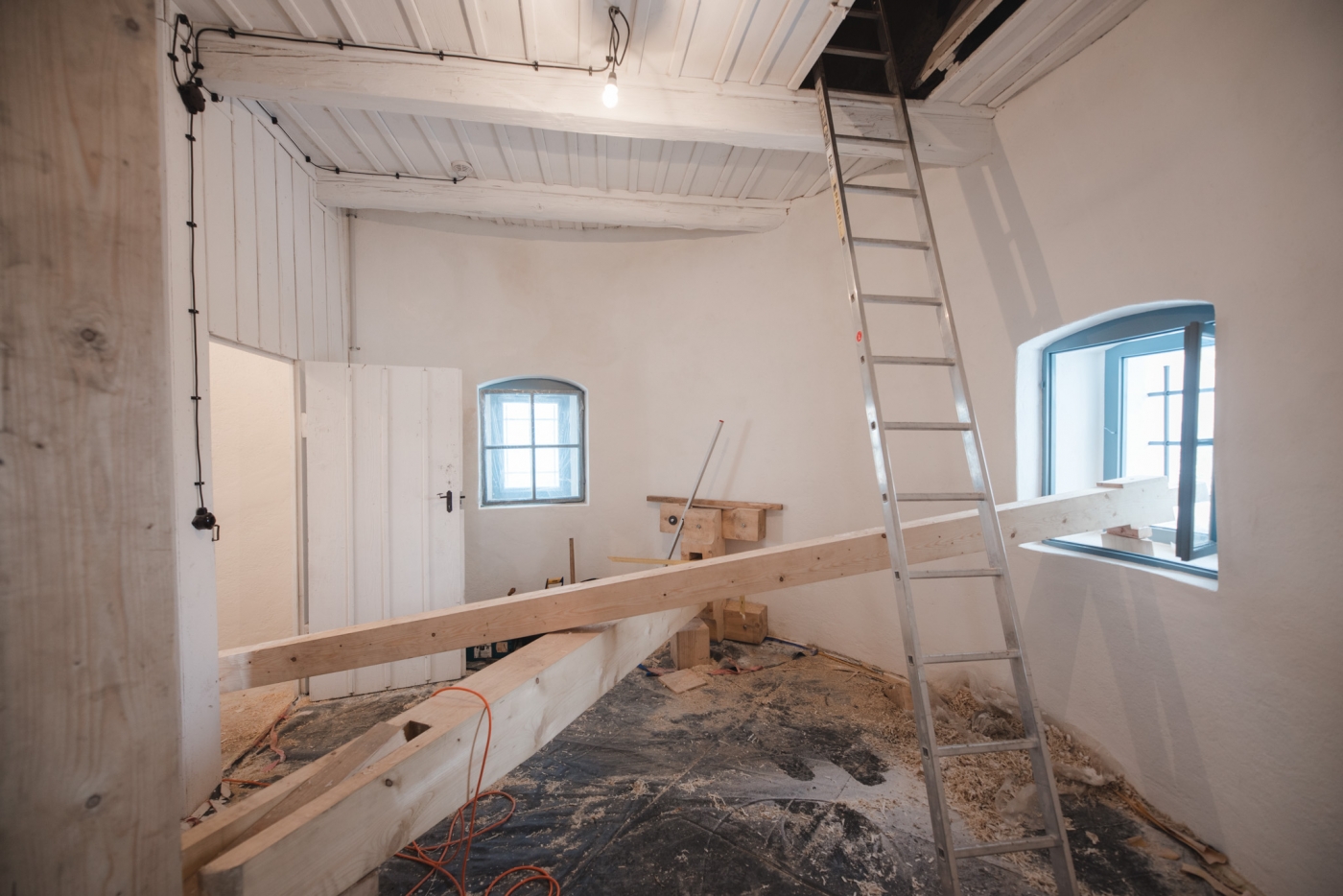

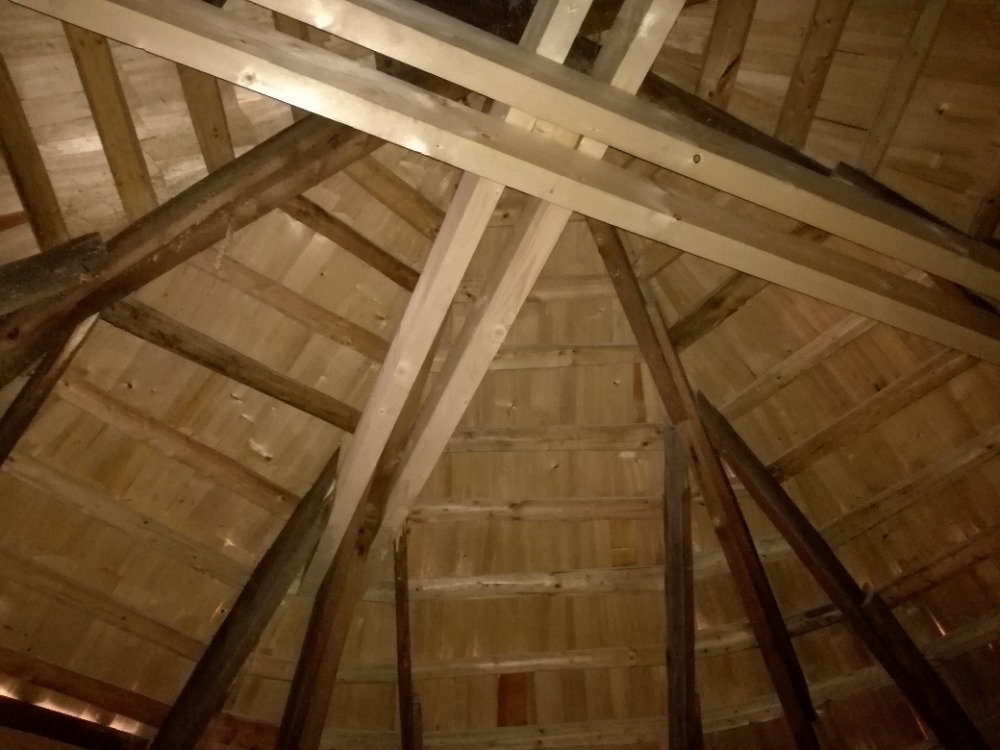

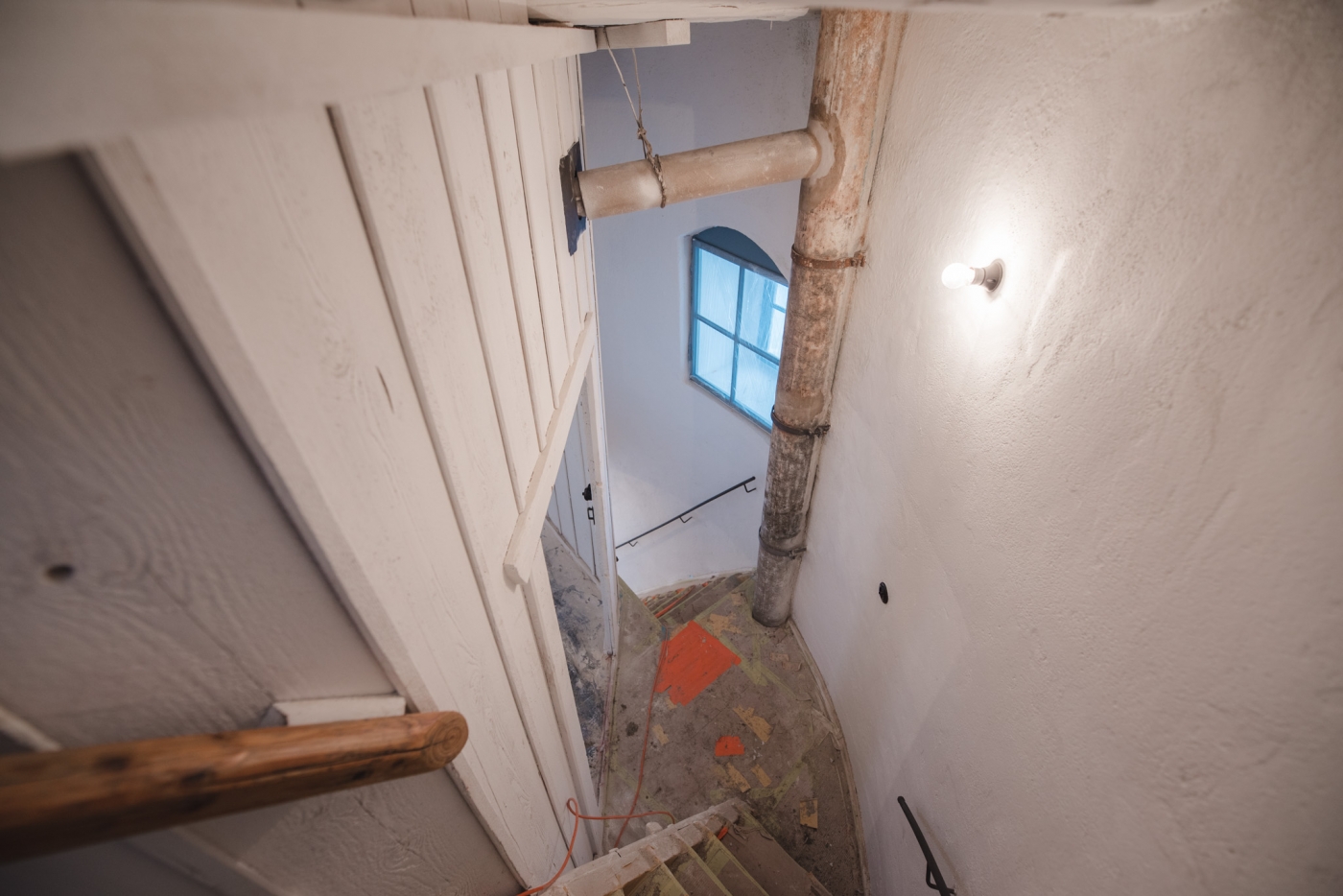

NOVEMBER 2020 - COMPLETION, COATING, FINAL ADJUSTMENT

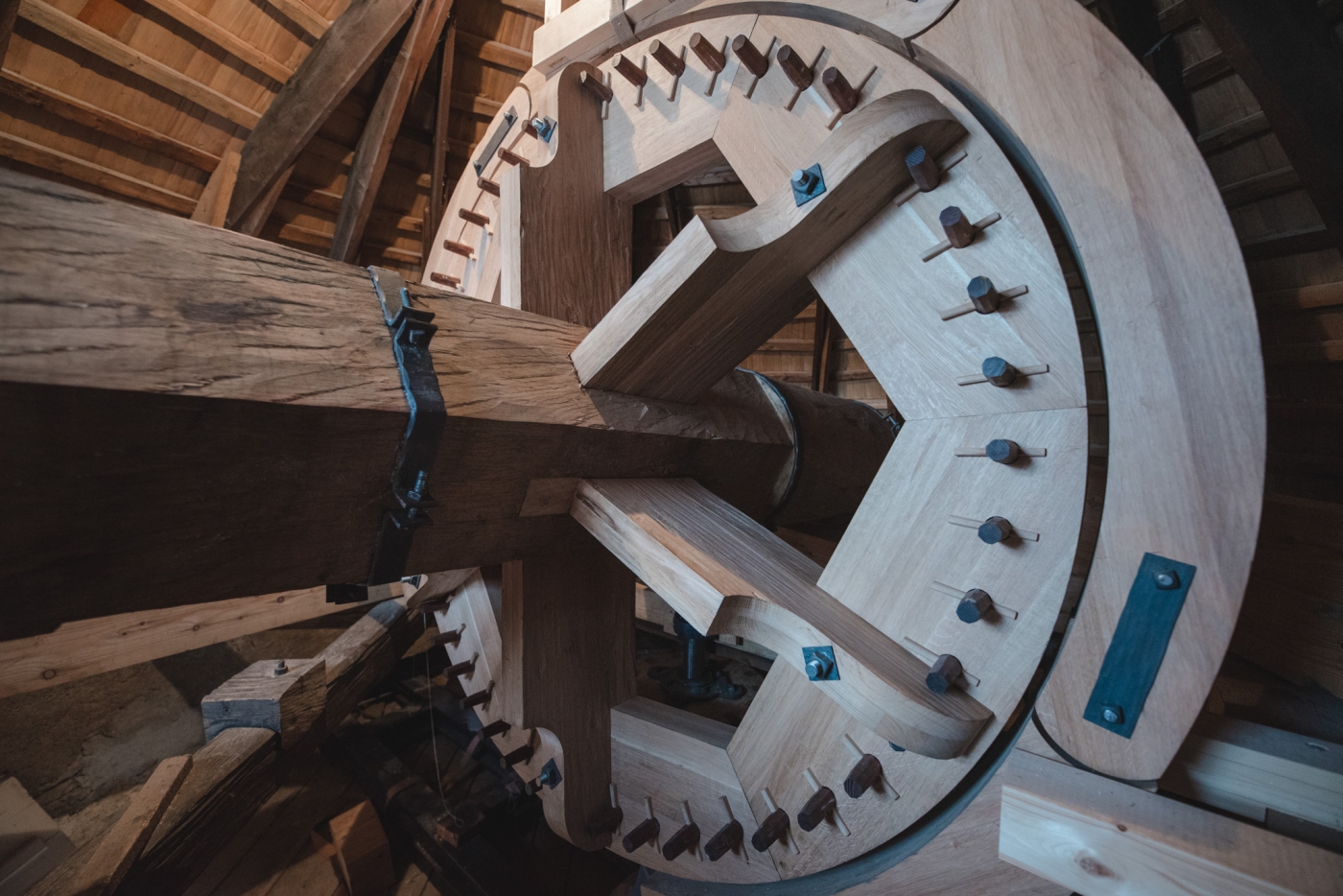

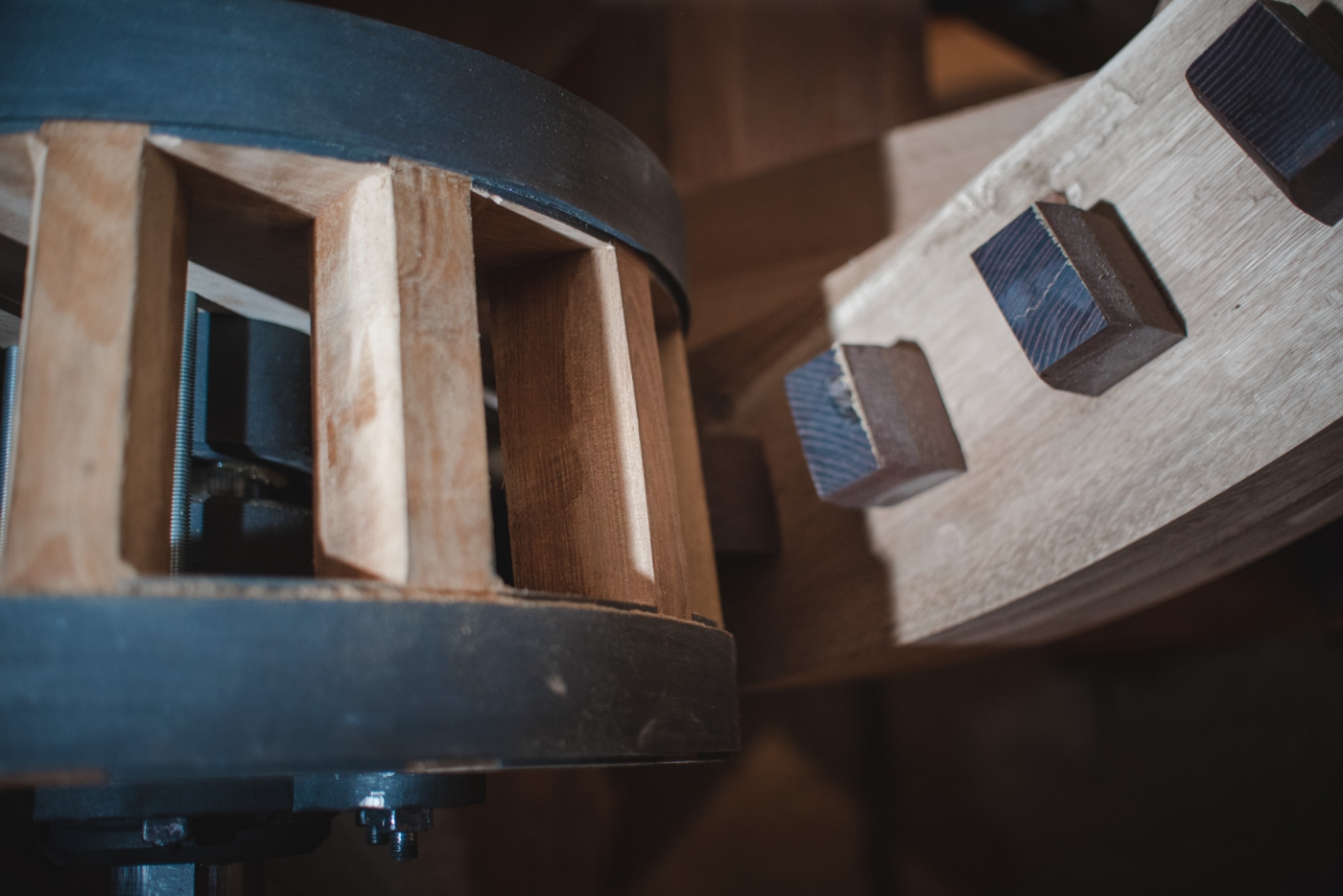

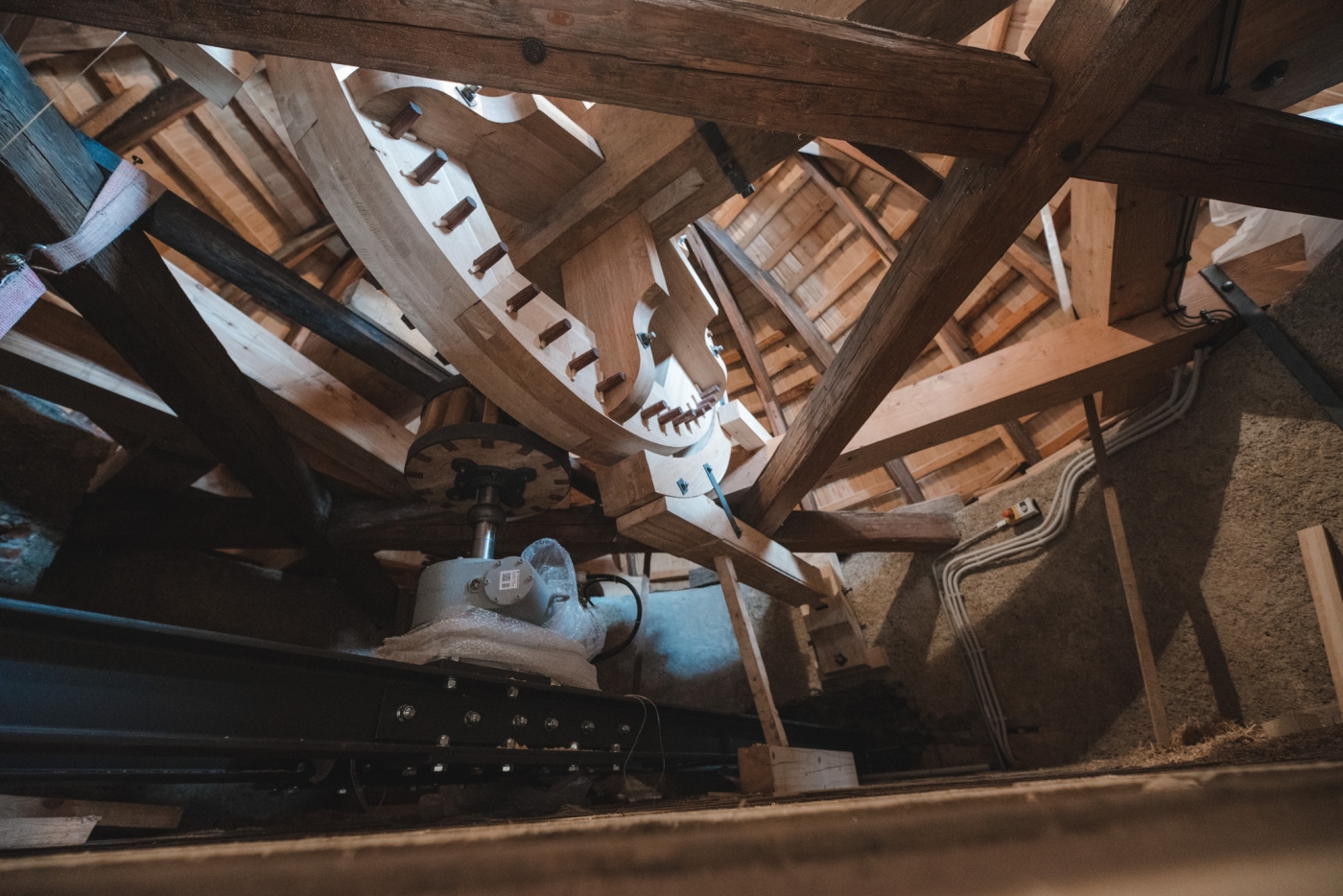

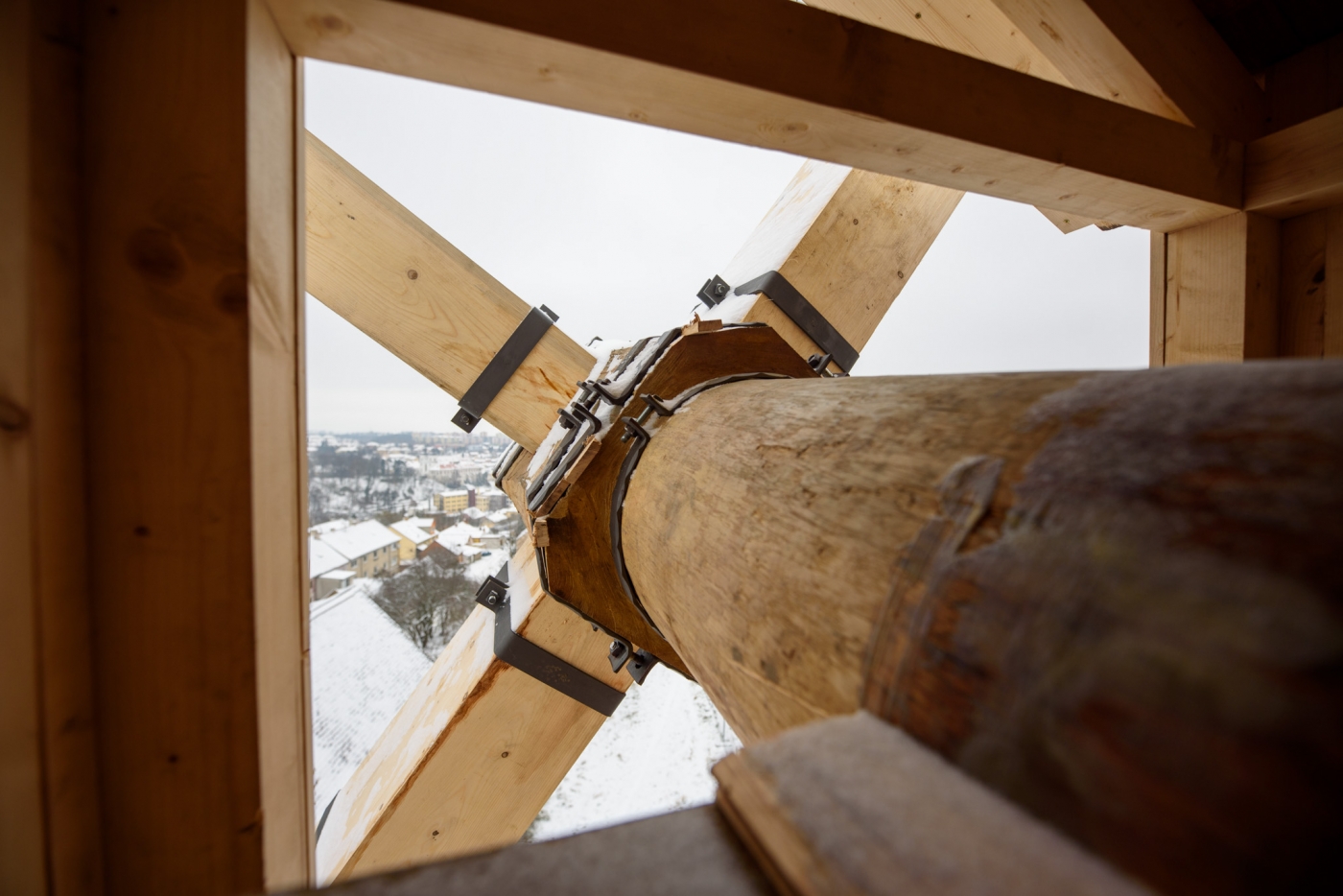

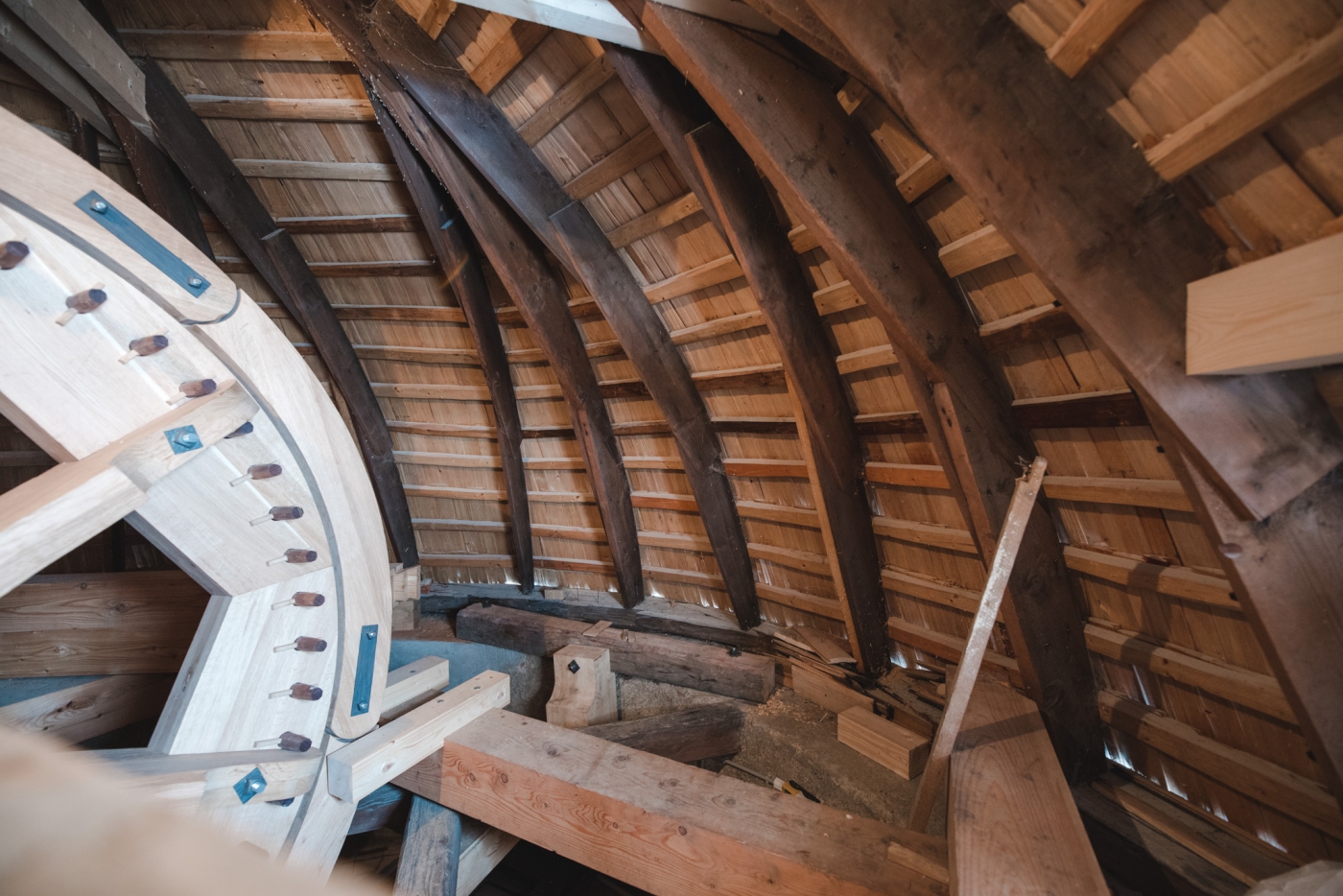

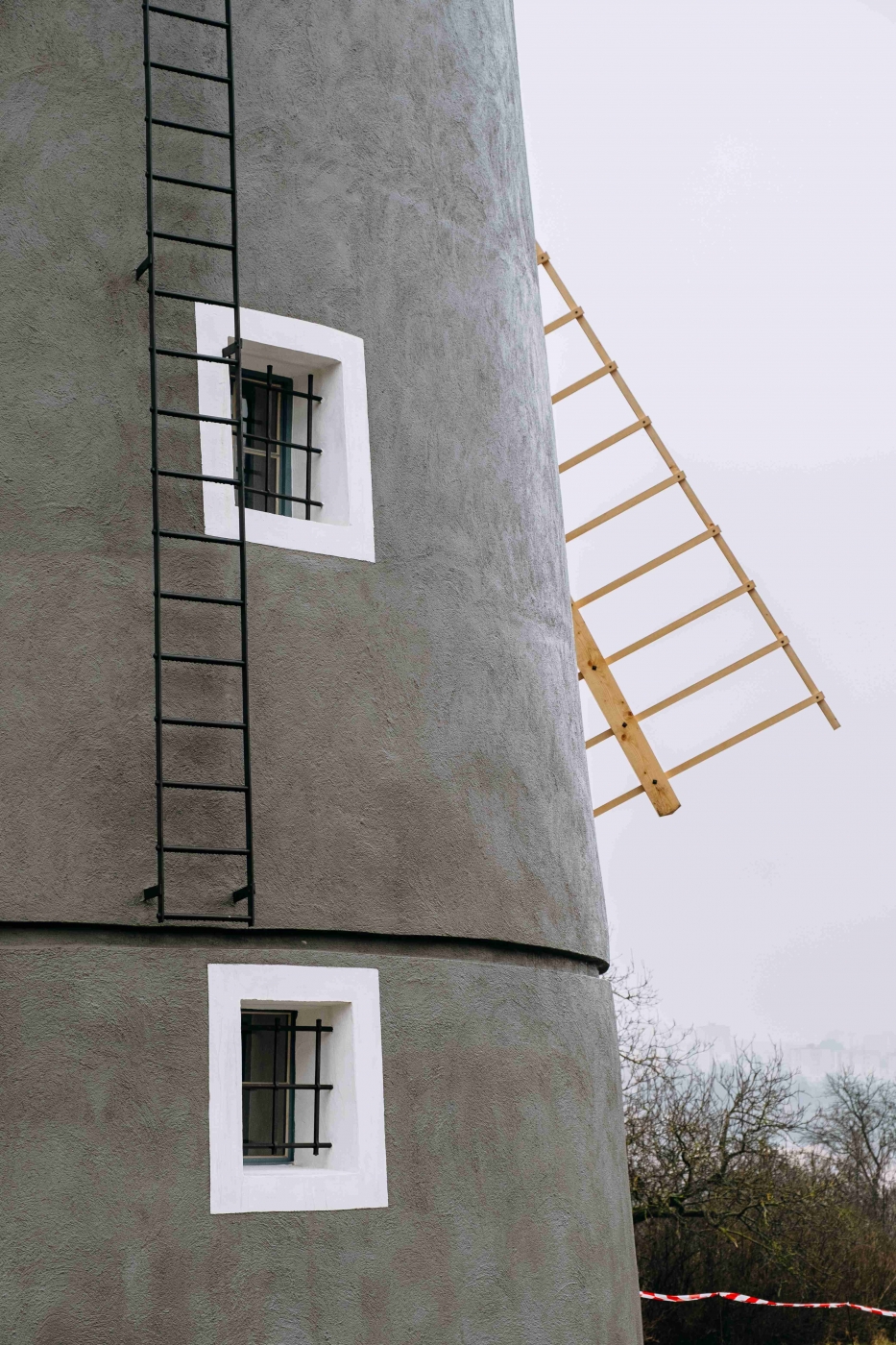

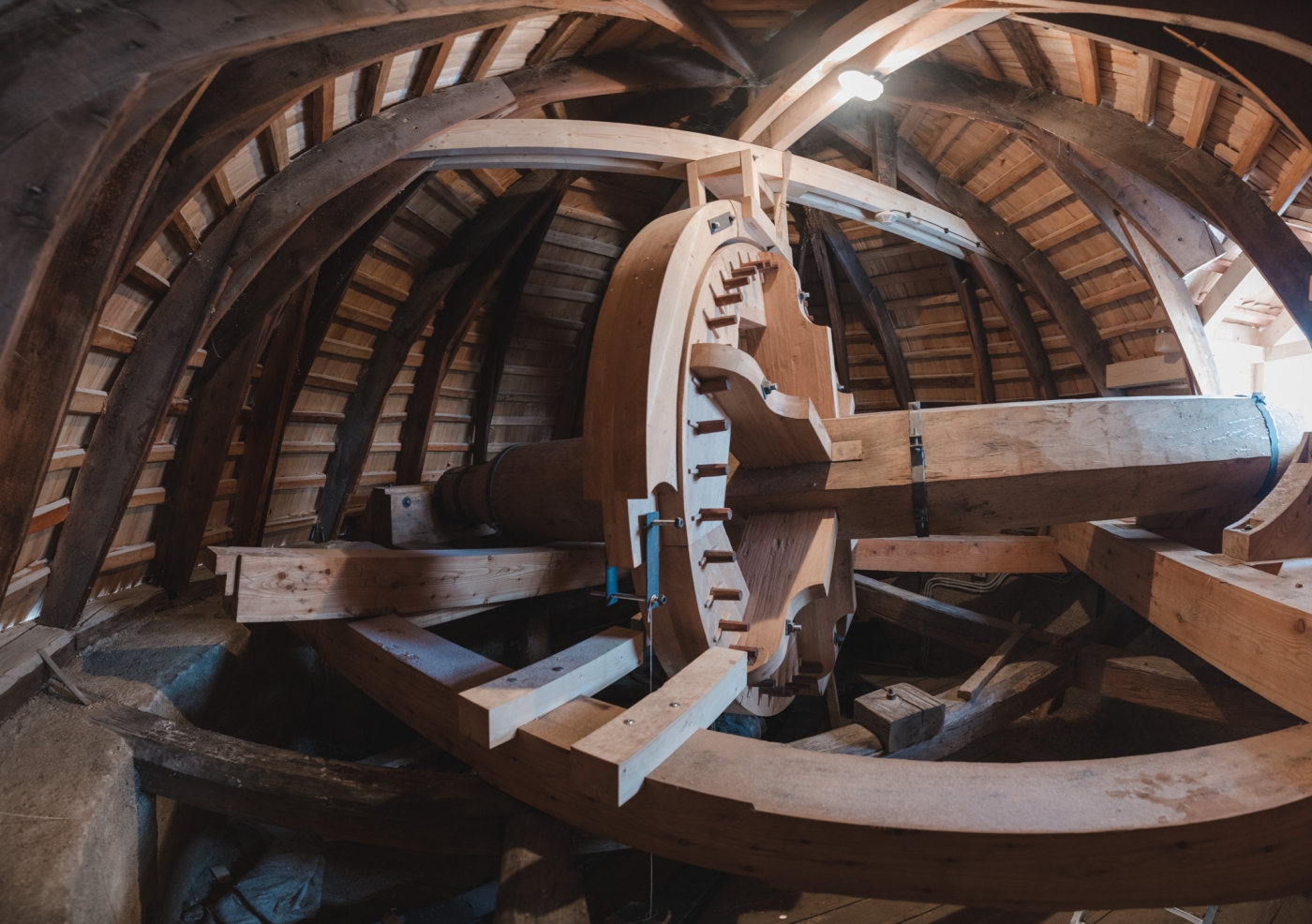

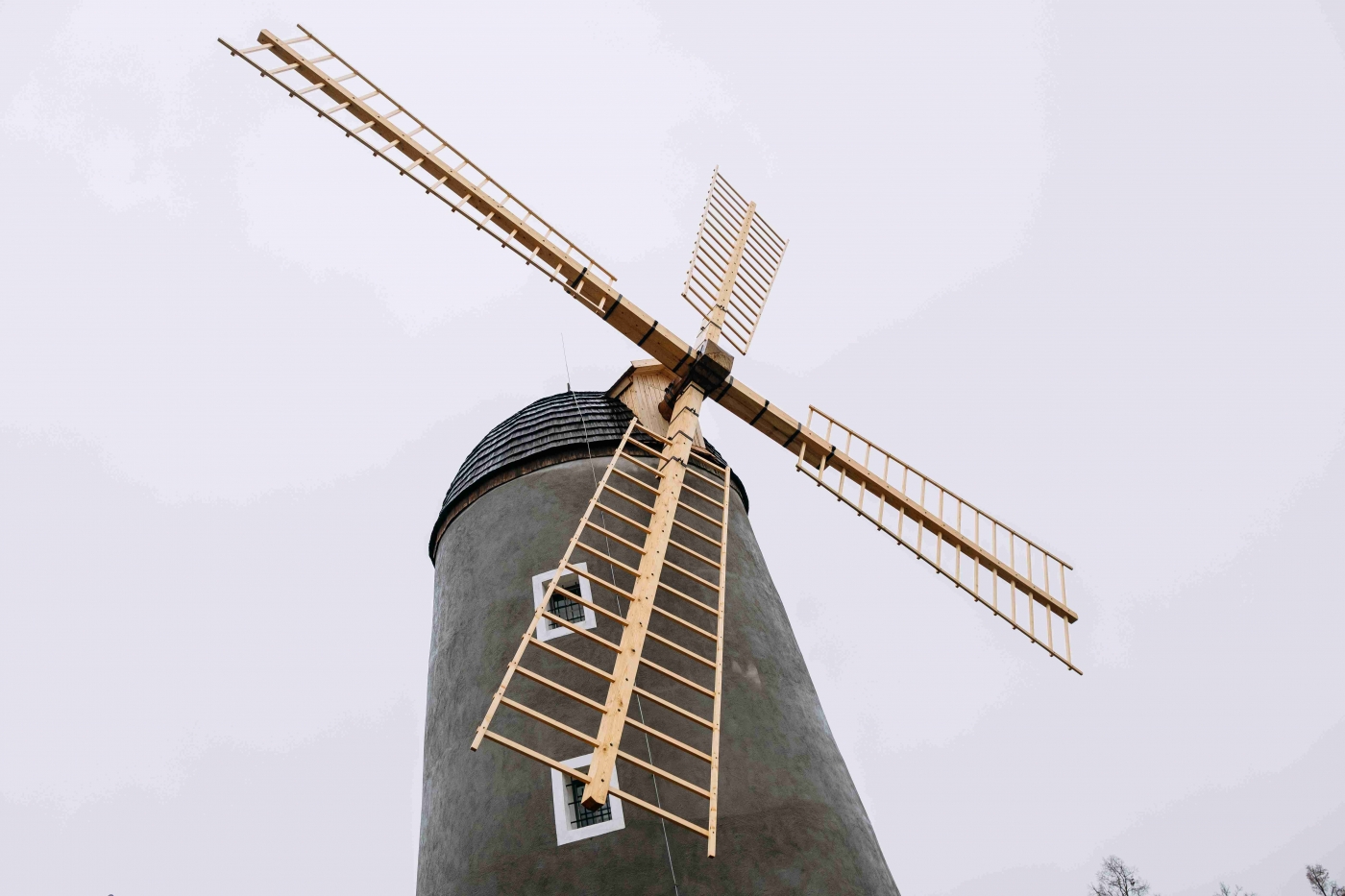

DECEMBER 2020 - INSTALLATION OF SHAFT, WHEEL, VASCLE WHEEL AND WINGS

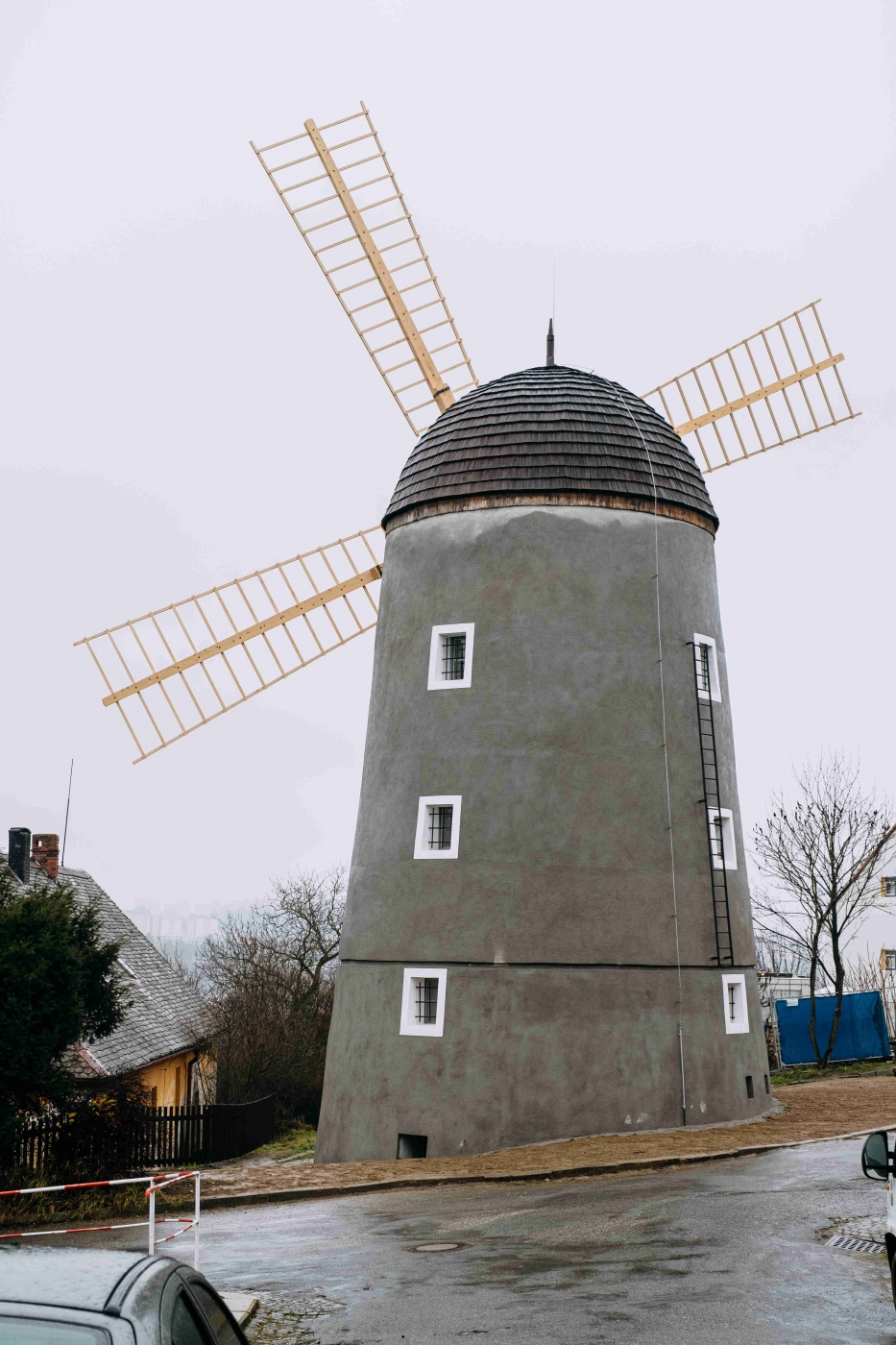

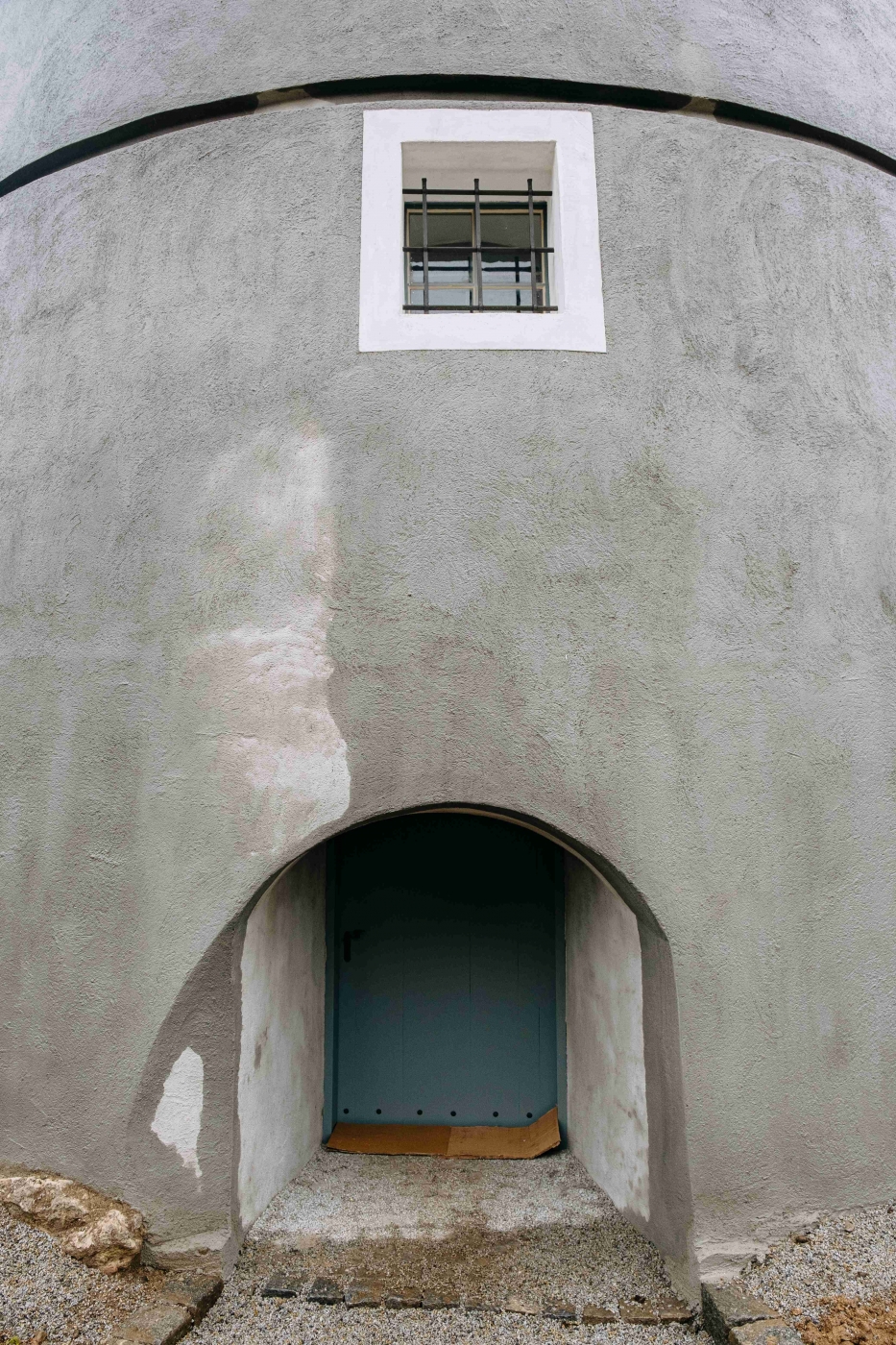

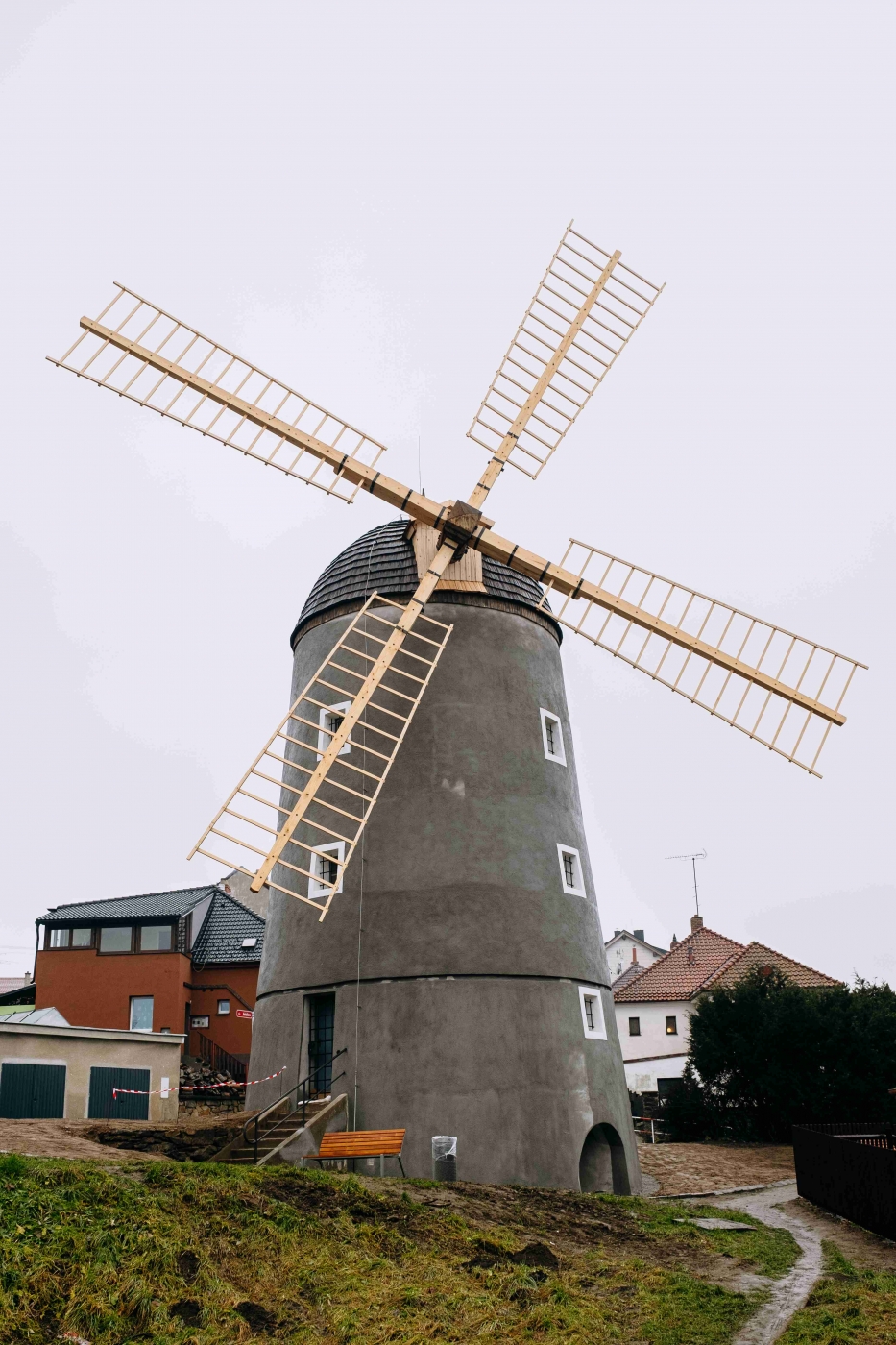

DECEMBER 2020 - FINISHING
